Utility
Ensuring robust utility support including air, power, and steam systems for uninterrupted and efficient plant performance.
Gantt Chart for Utility
Day 01
16/04/2026

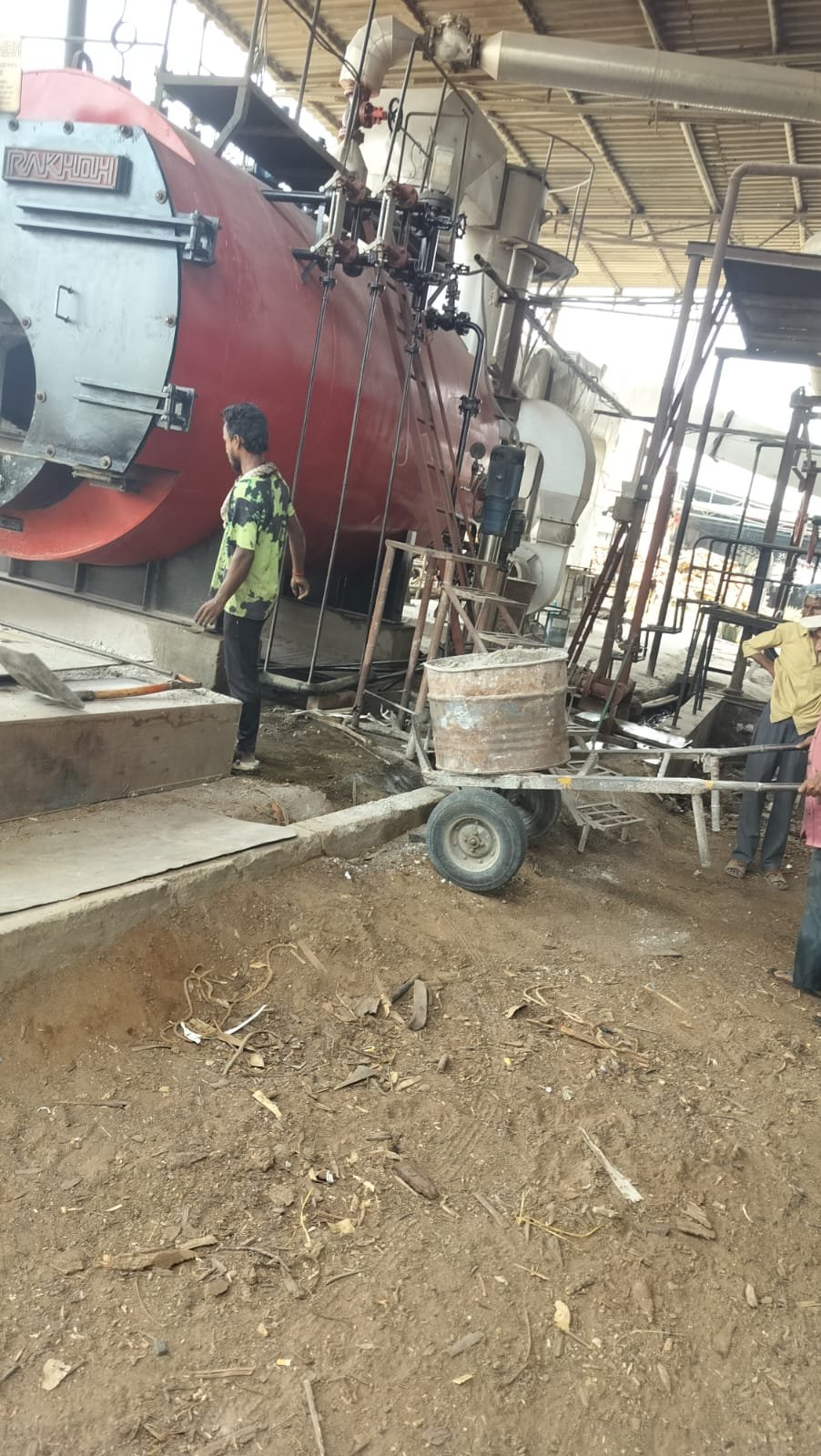

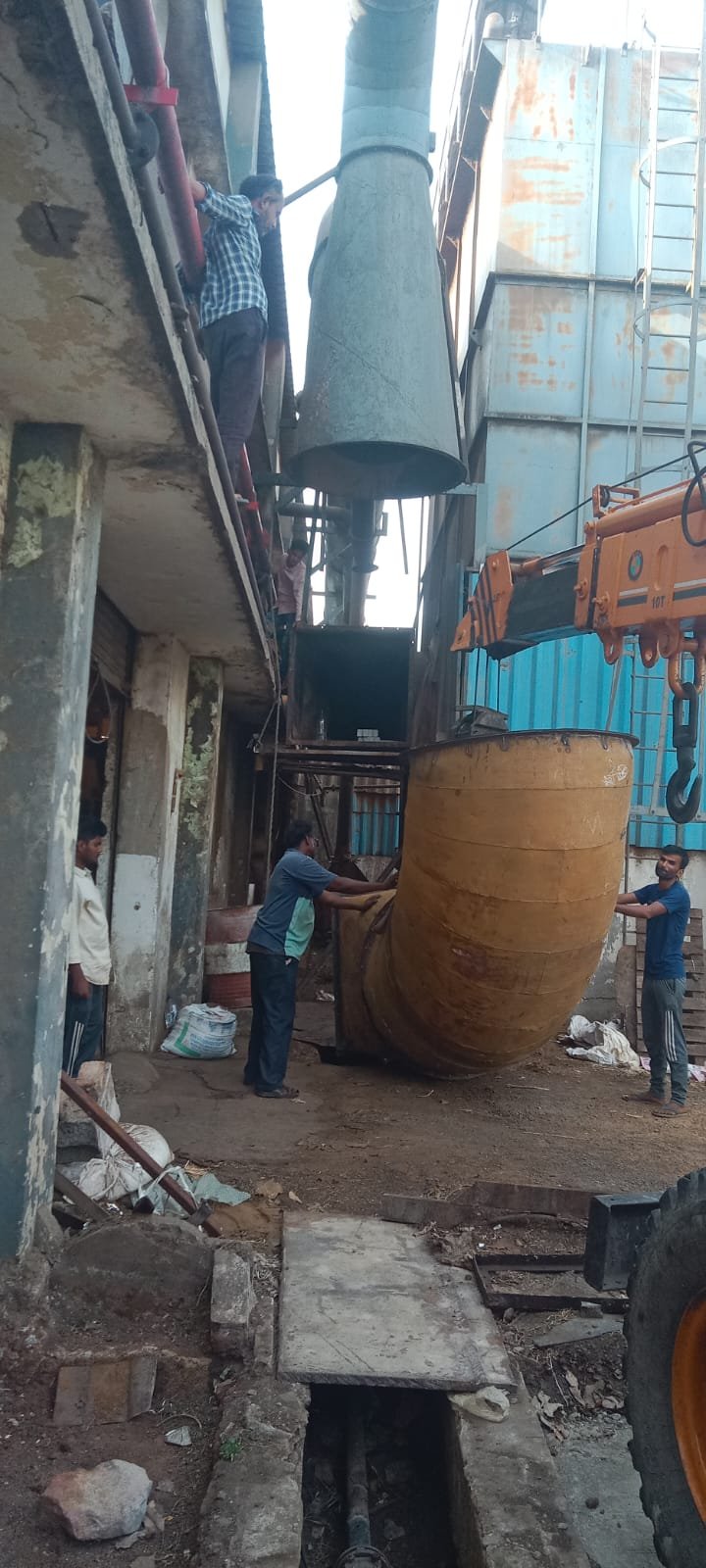

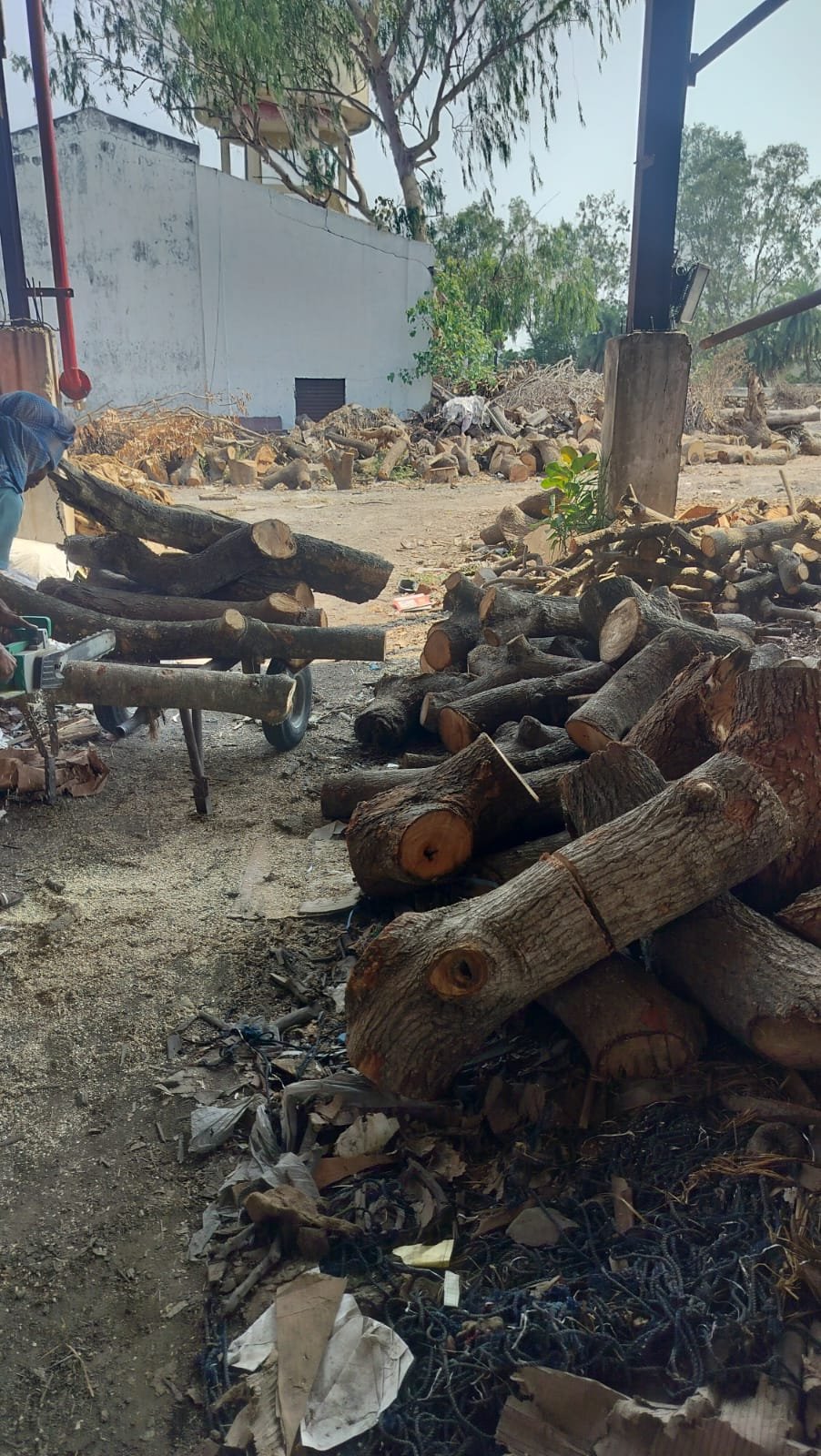

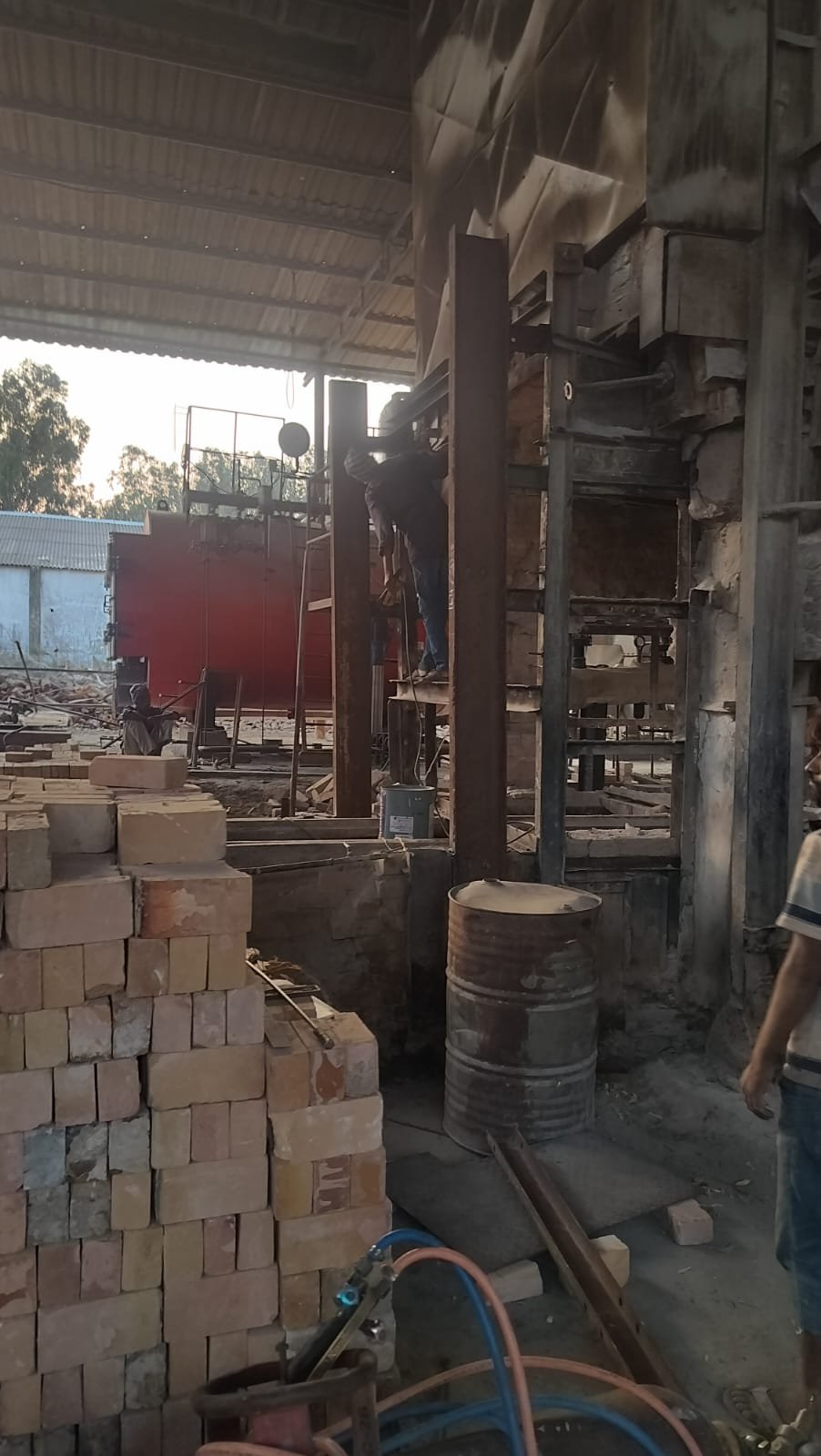

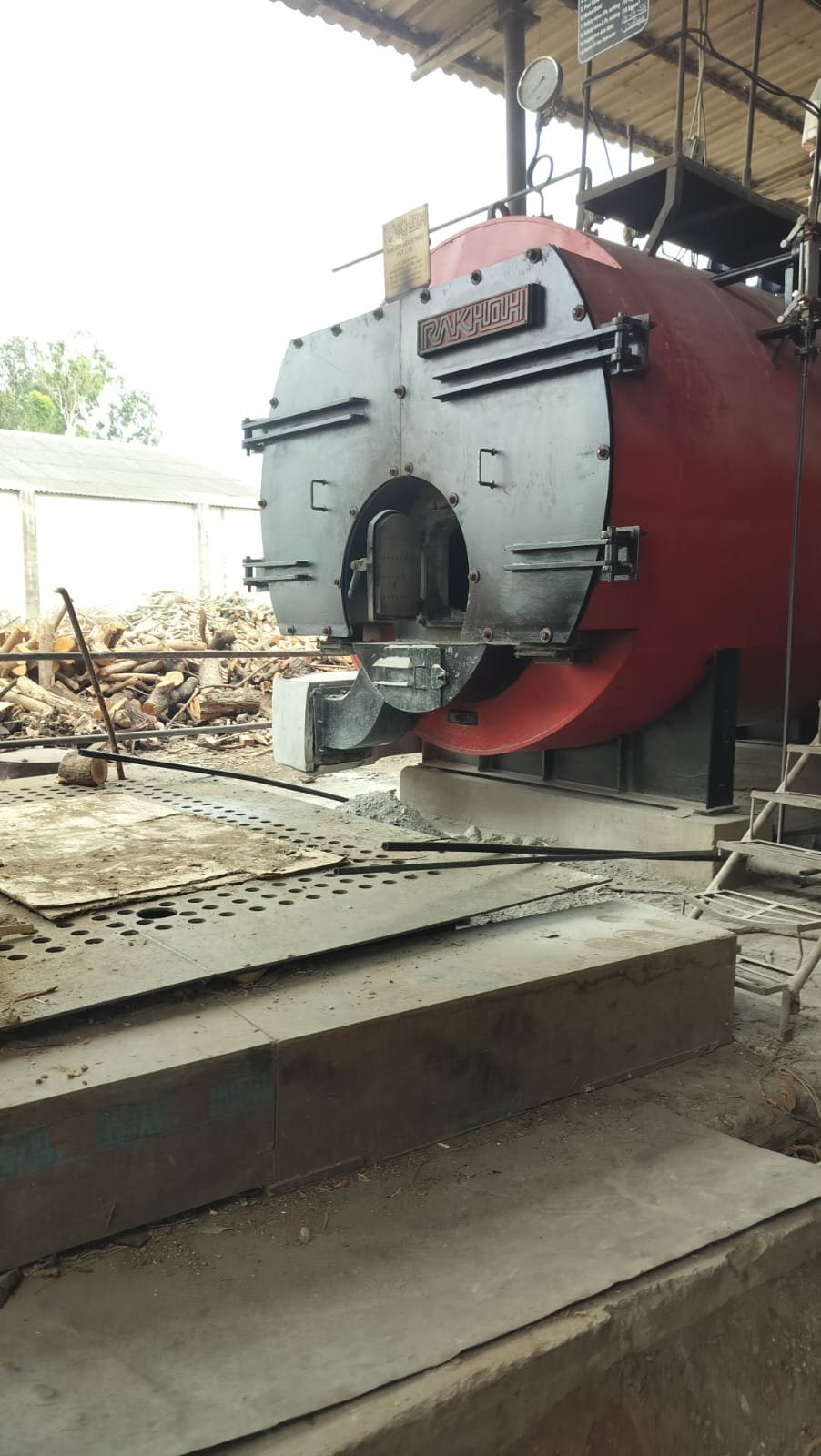

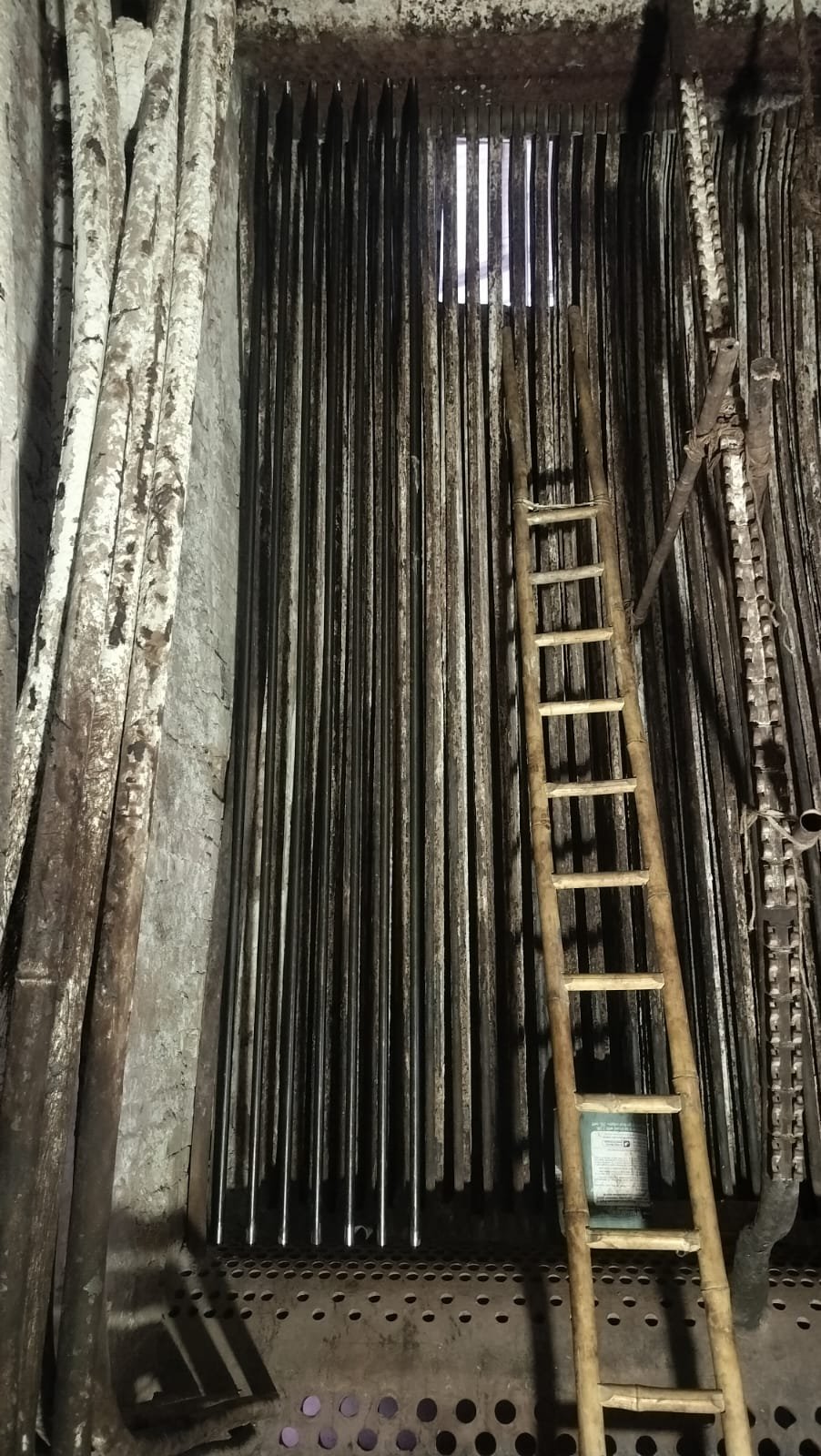

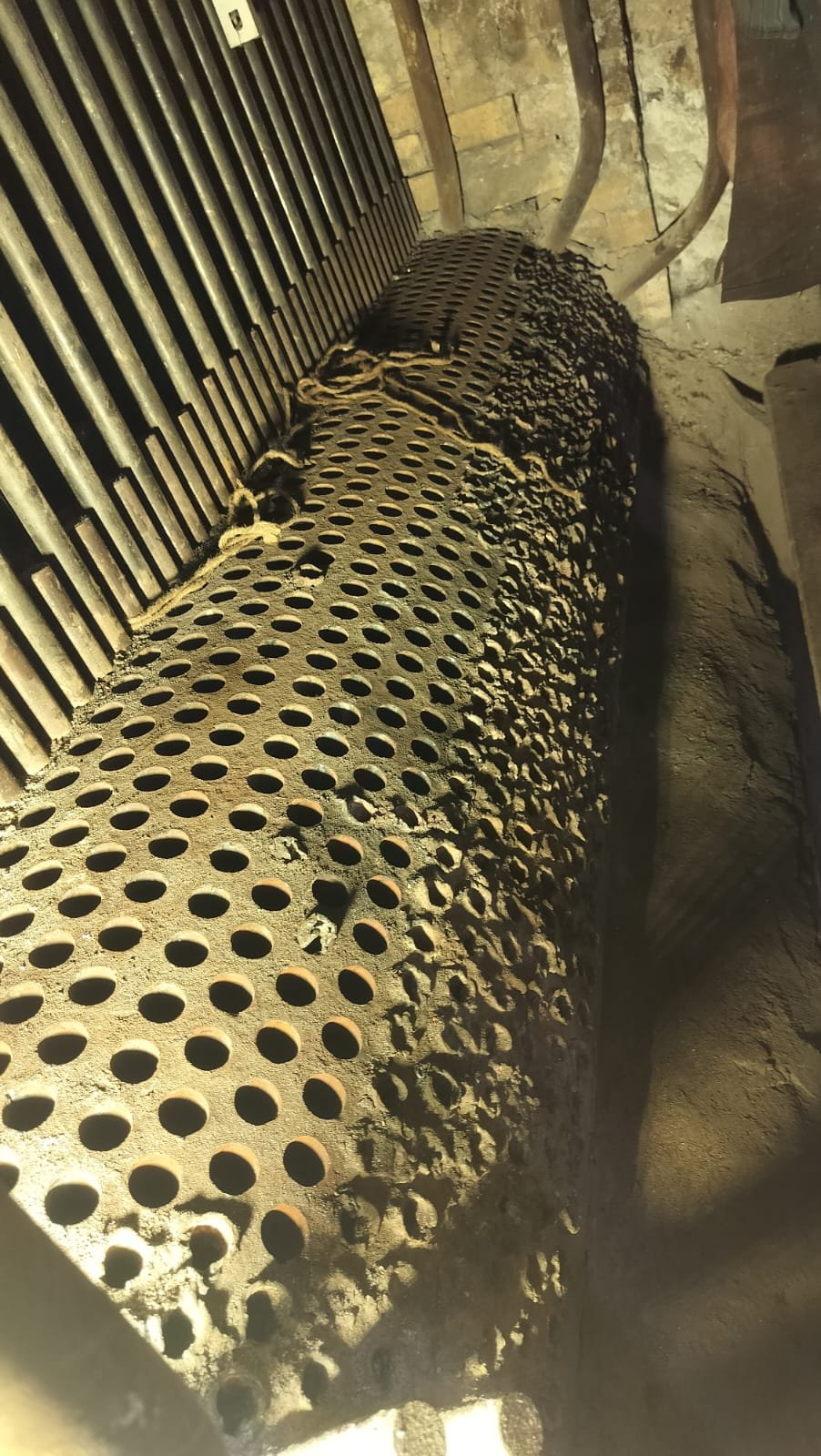

Rakho Boiler Cleaning And furness Dust Removing. Shifting And Dumping Yard Boiler Back Side.Boiler Heavy Wood Cutting Starting.



Day 02
17/04/2026

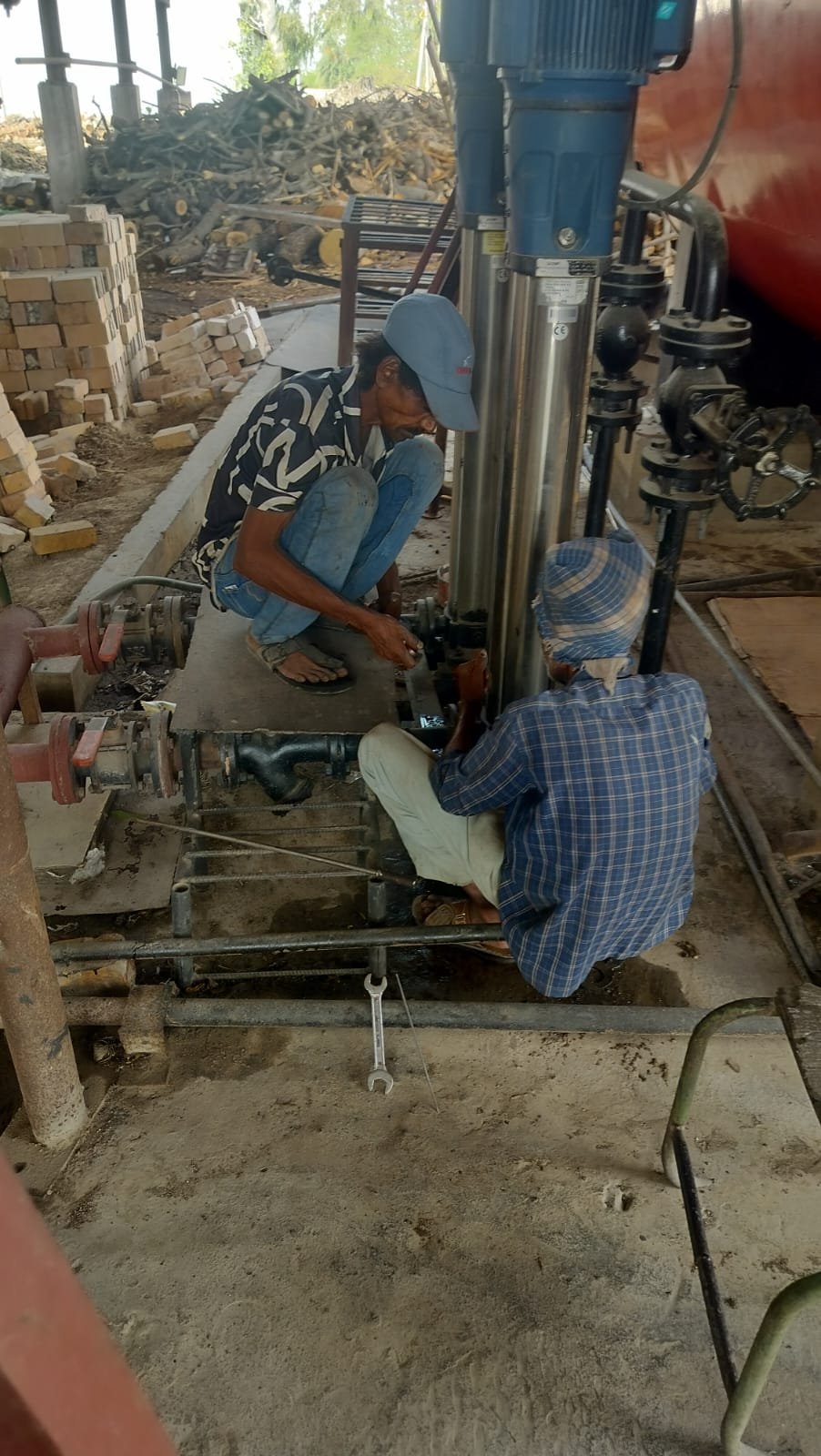

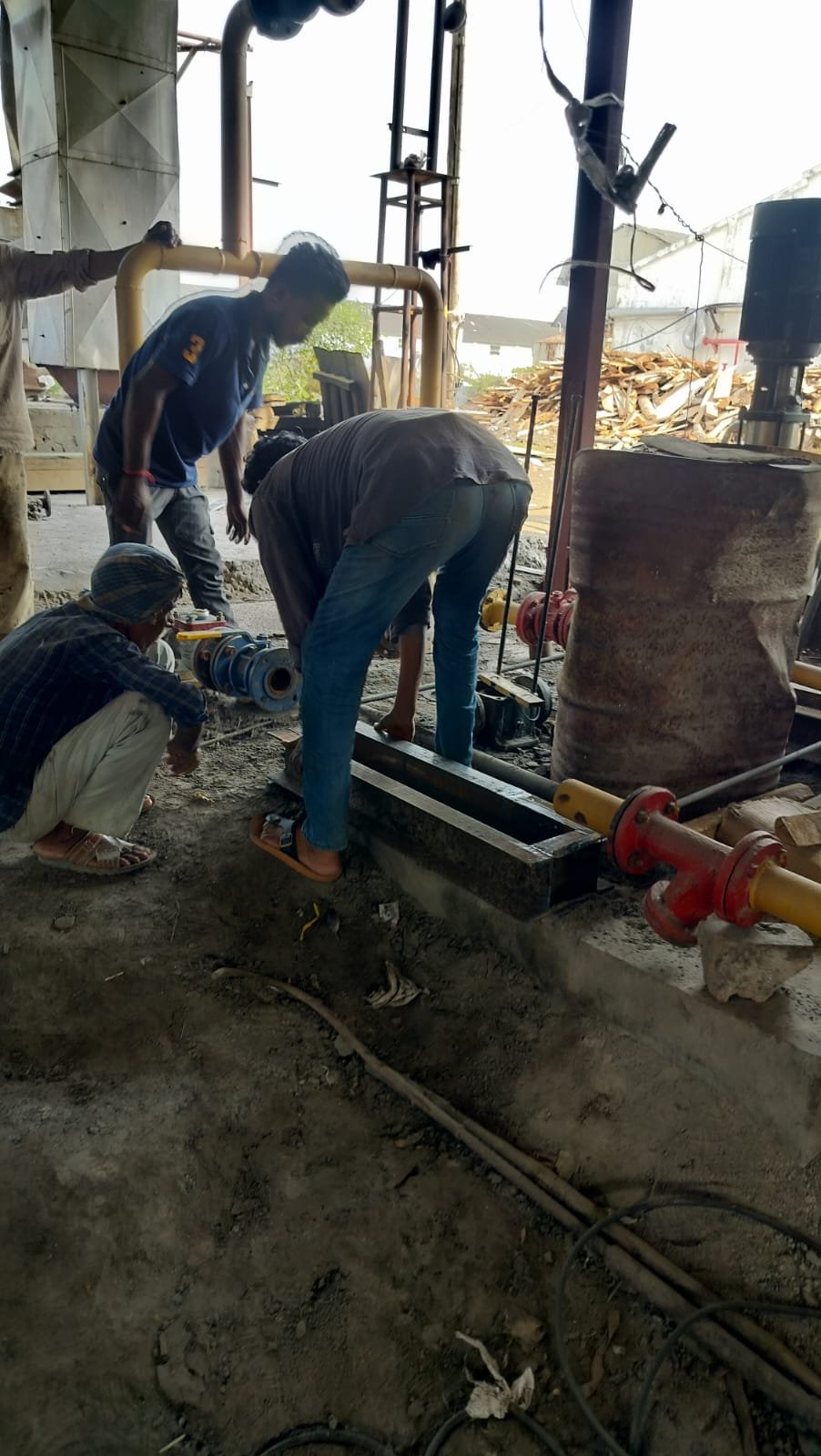

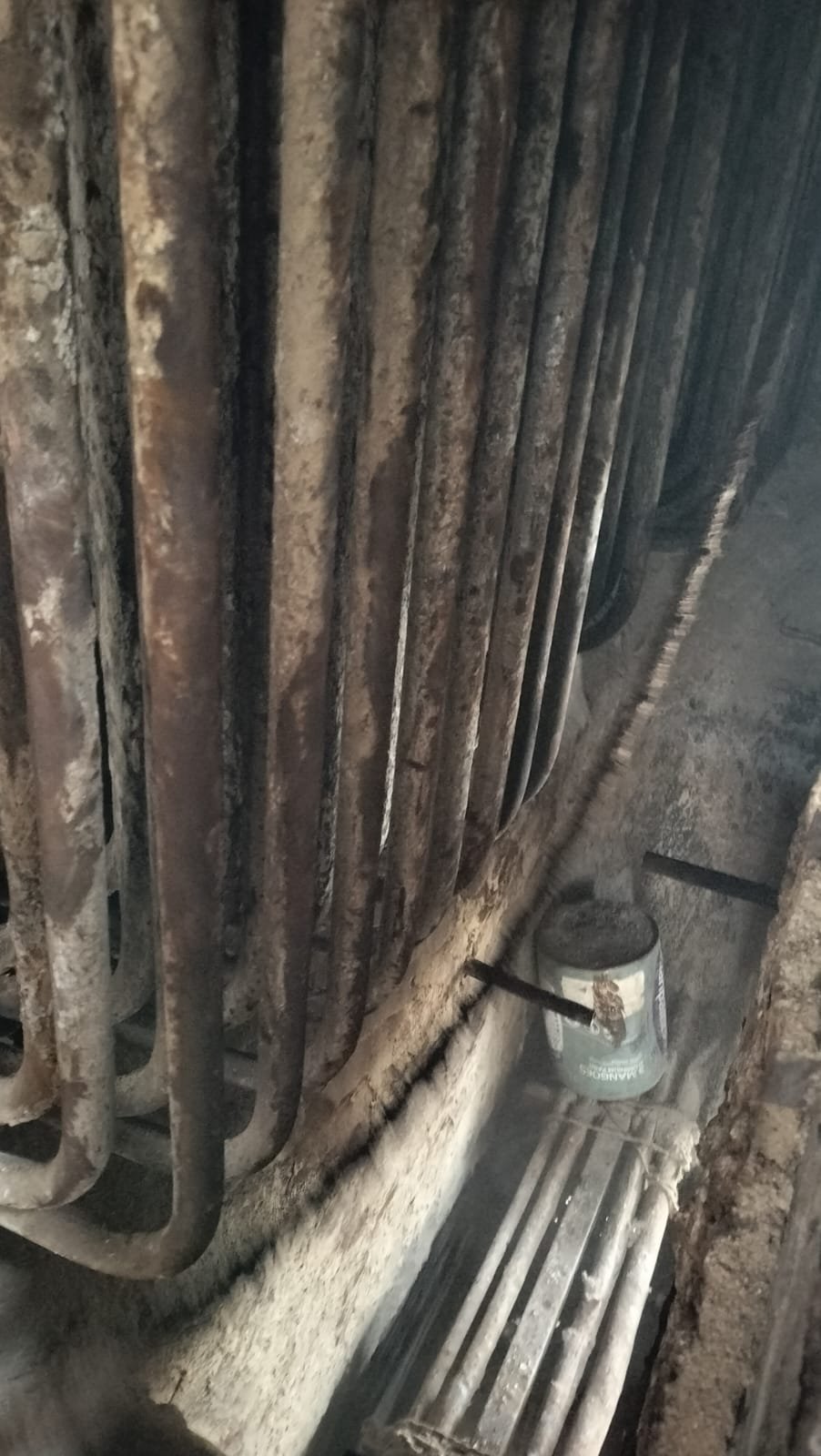

Boiler Feed Water 2 Tanks Cleaning Working Proces.2″ Condenser Water Pipe Line And Wall Checking . Heavy Wood Working Proces .



Day 03
18/04/2026
Boiler Feed Water 2 Tanks Cleaning Working Proces.2″ Condenser Water Pipe Line And Wall Checking .Over Head Tank To Direct Water New Line.



Day 04
19/04/2026
Boiler Feed Water 2 Tanks Cleaning Working Proces.3″ Over Head Gate wall Replecing New One .Heavy Wood Working Proces



Day 05
20/04/2026

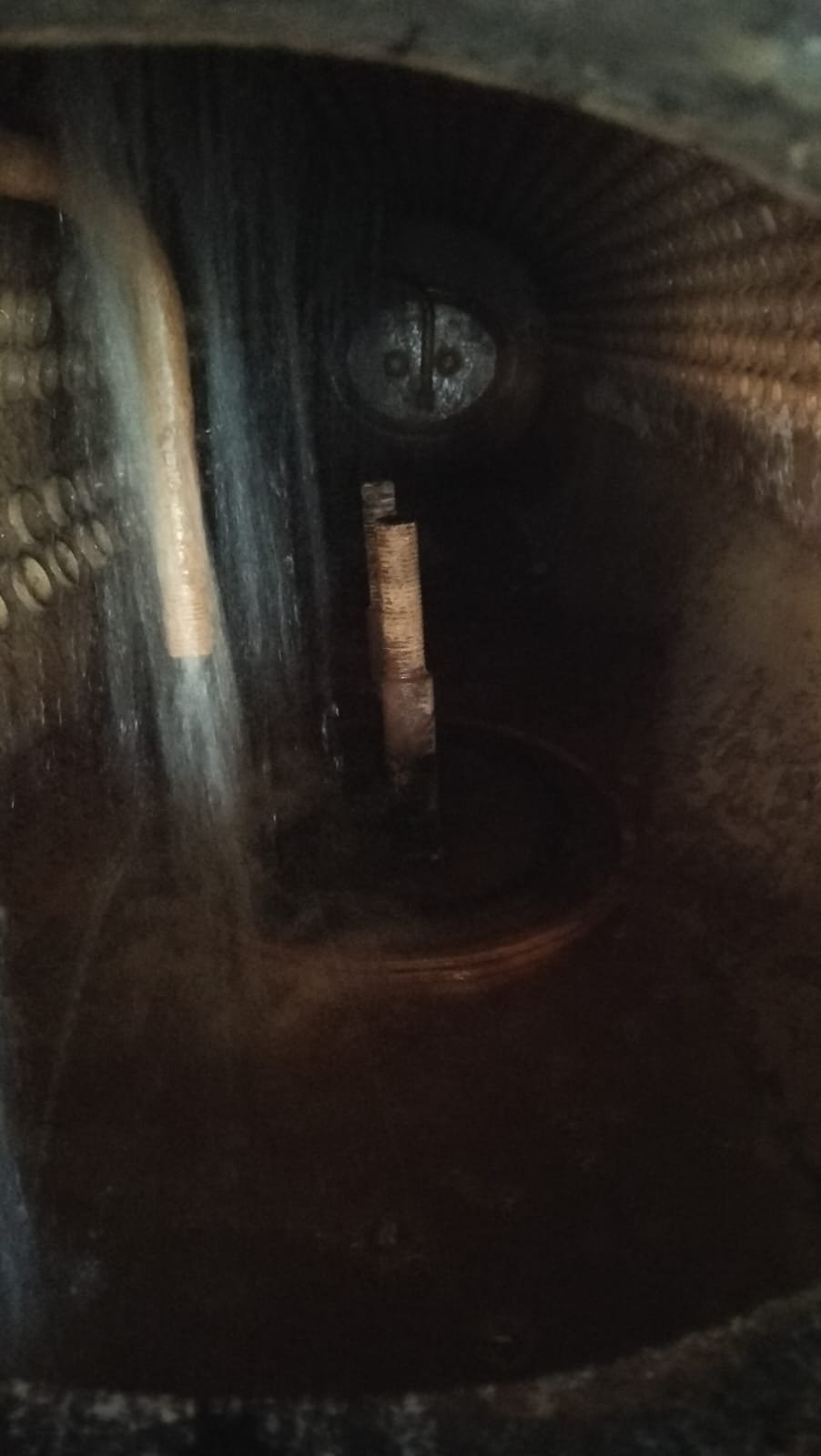

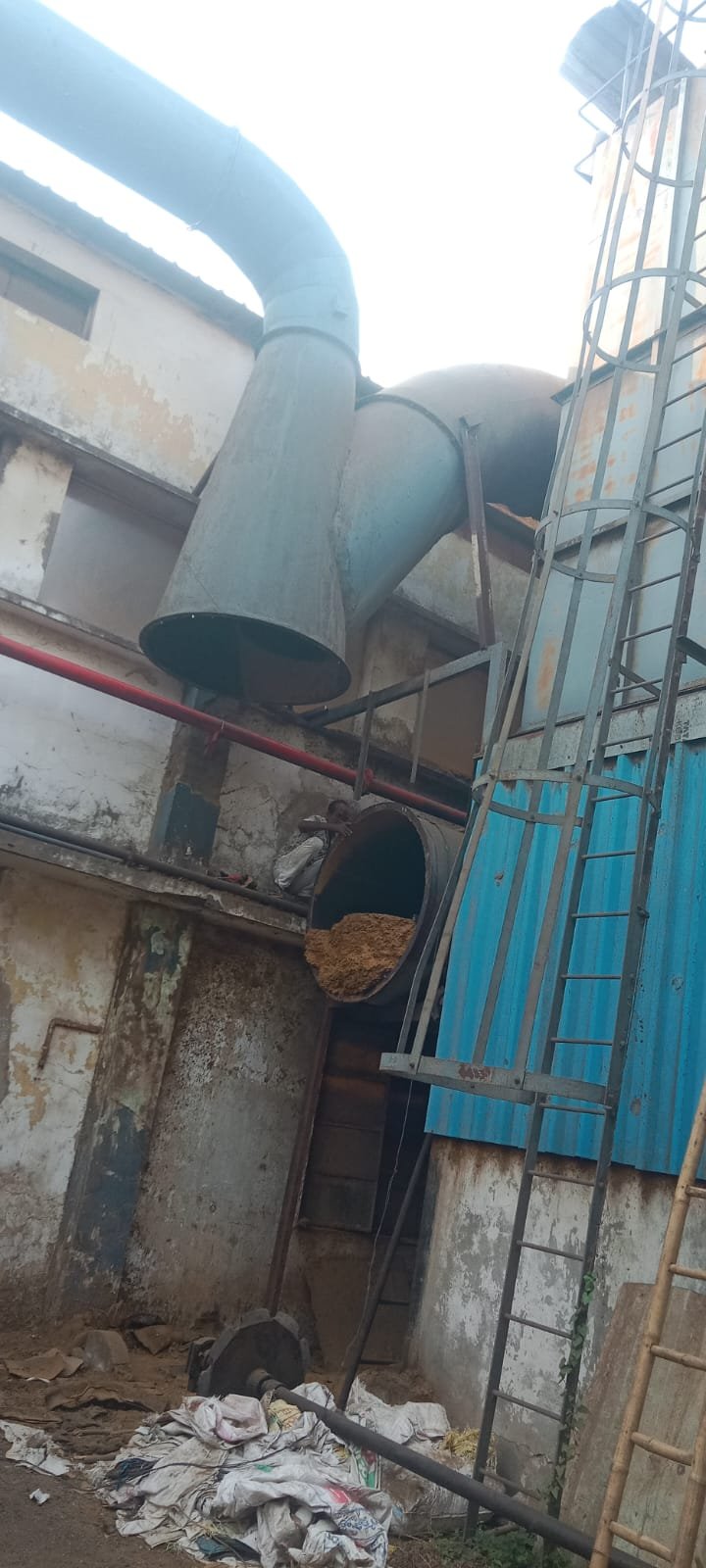

Boiler Feed Water 2 Tanks Copleted. Z Venteletor Work Sample In MC Hall Completed.DRF Duct Bend Removing Working Proces.



Day 06
21/04/2026

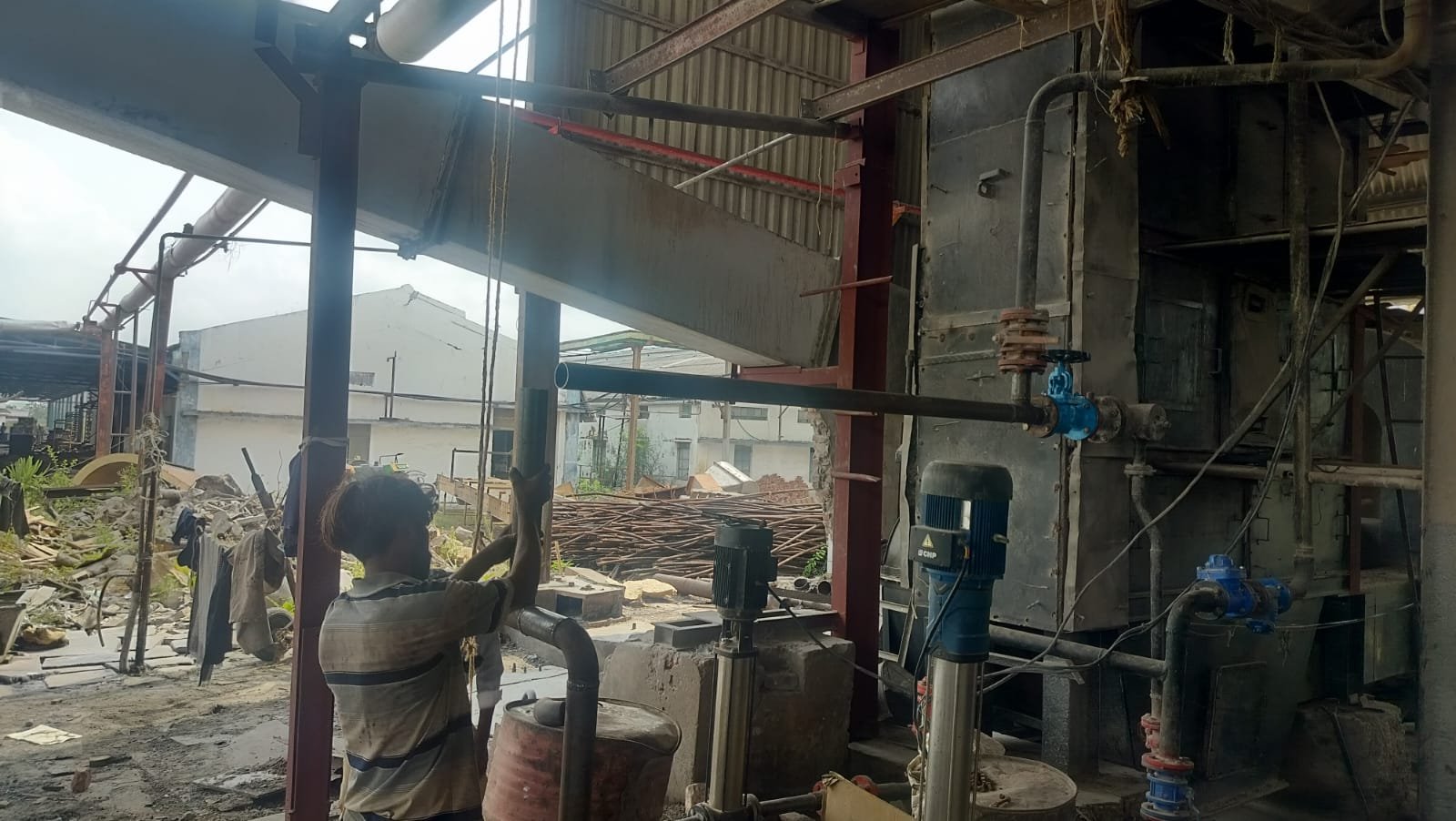

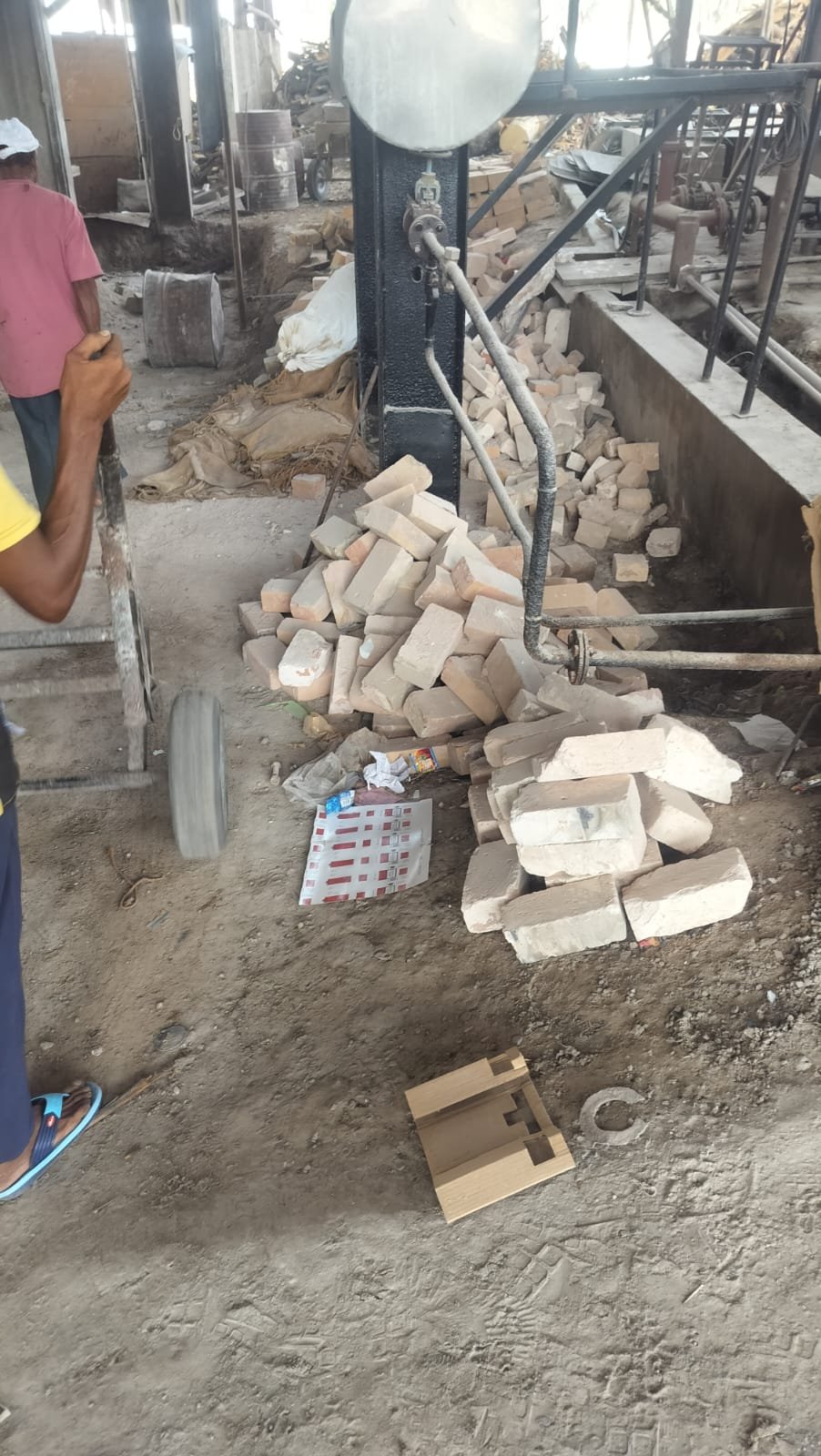

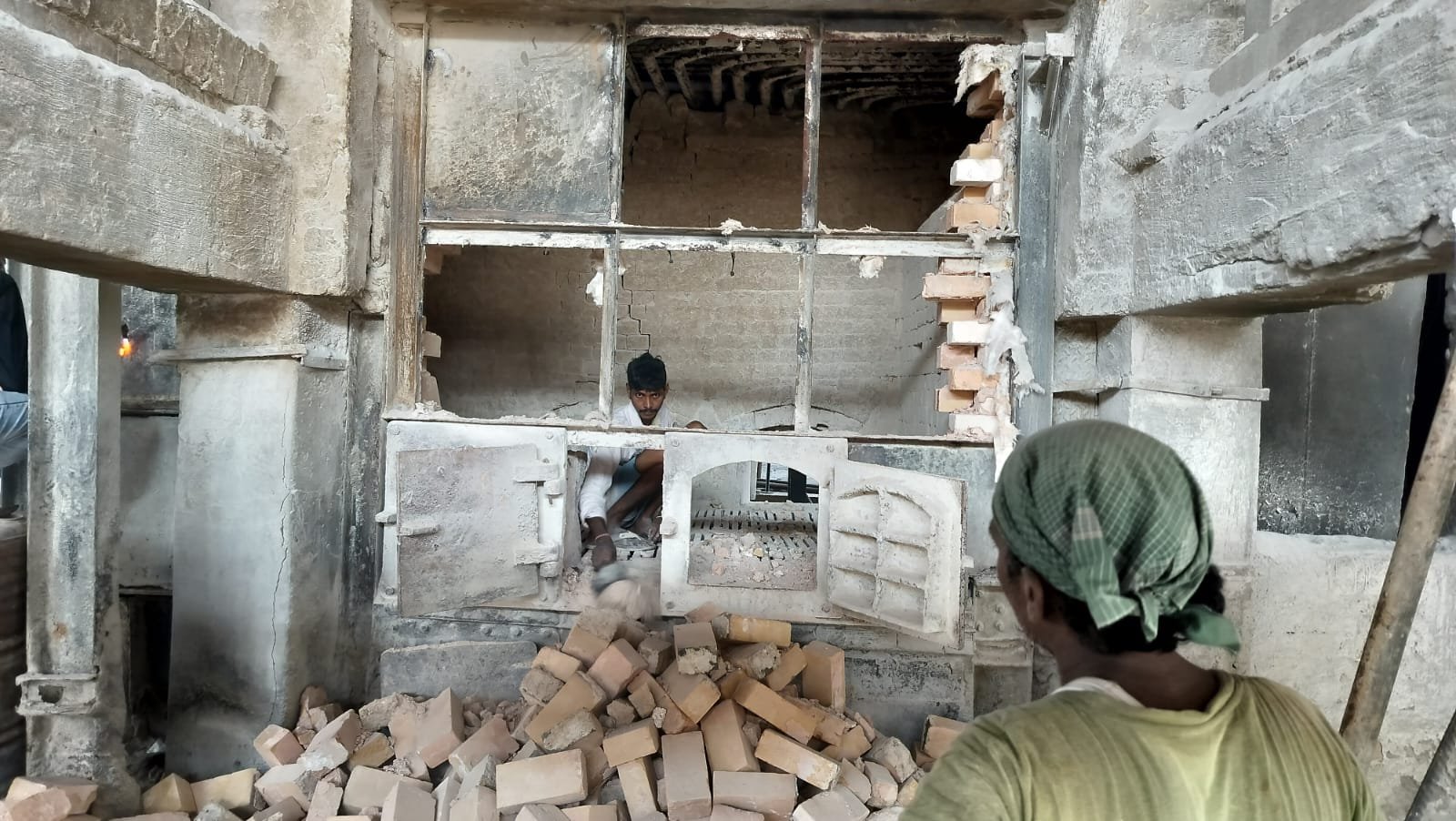

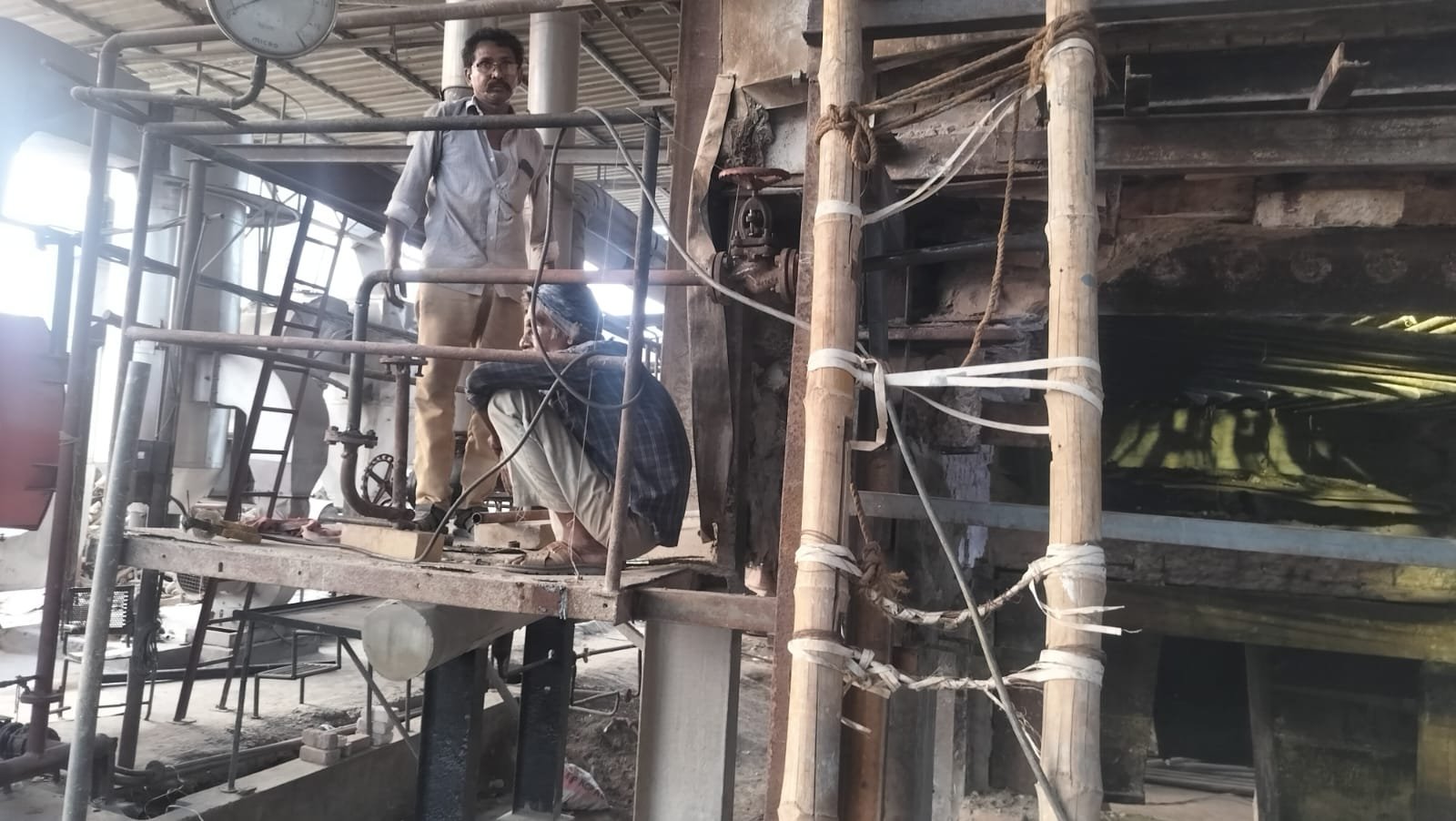

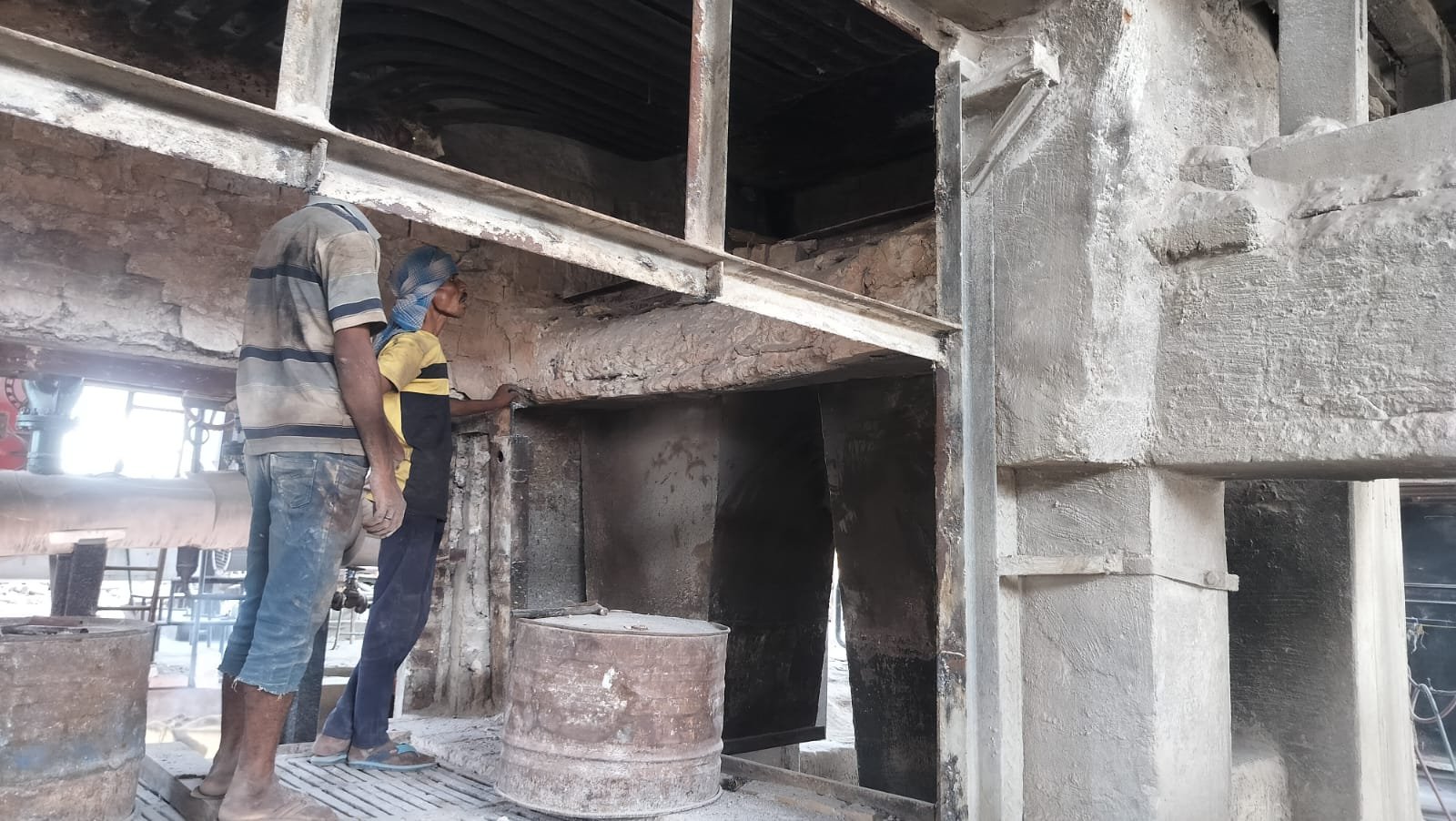

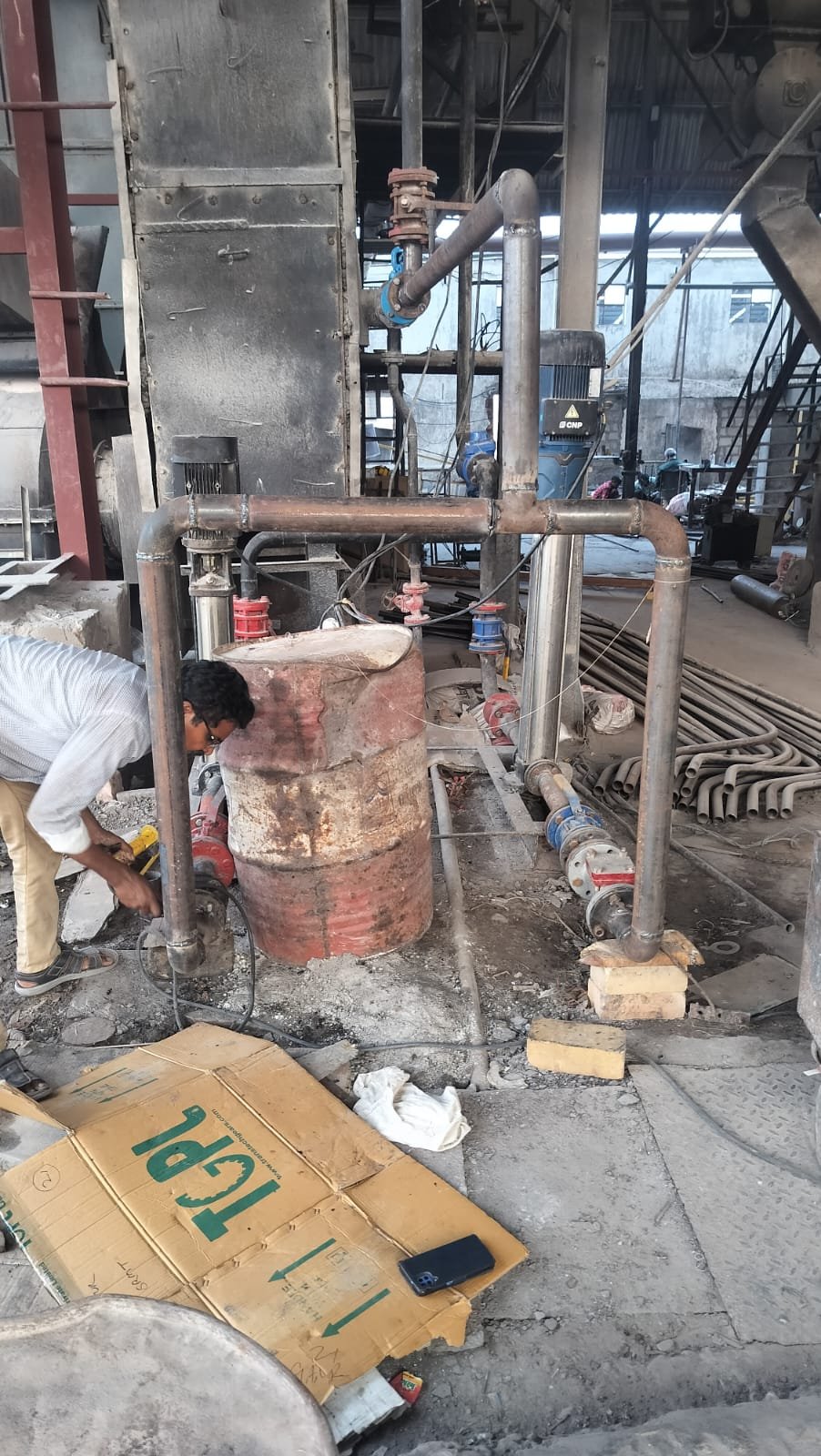

Boiler All Walls Open & Servecing Working Proces.Pre heaters Two Sump Cleaning Working Process.Condenser Water Line 2″ Line Working Process.



Day 07
22/04/2026
- Total Planned Activity : 35nos
- Ongoing Activity : 7 Nos
- Completed Activity : 3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 1.5



Day 08
23/04/2026
- Total Planned Activity : 35 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 1.5



Day 09
24/04/2026
- Total Planned Activity : 35 nos
- Ongoing Activity : 5 Nos
- Completed Activity : 3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 2.2


Day 10
25/04/2026
- Total Planned Activity : 35 nos
- Ongoing Activity : 4 Nos
- Completed Activity : 3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 2.1



Day 11
27/04/2026
- Total Planned Activity : 35 nos
- Ongoing Activity : 3 Nos
- Completed Activity :3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 1.9



Day 12
28/04/2026
- Total Planned Activity :35 nos
- Ongoing Activity : 4 Nos
- Completed Activity :3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 1.9


Day 13
29/04/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 4
- Completed Activity : 3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 2.1
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 14
30/04/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 4
- Completed Activity : 3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 2.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 15
02/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 3
- Completed Activity : 3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 16
04/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 3
- Completed Activity :3
- Percentage Completion :8.6%
- SPI – Scheduled Performance Index : 1.7
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 17
05/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 3
- Completed Activity : 3
- Percentage Completion : 8.6%
- SPI – Scheduled Performance Index : 1.6
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 18
06/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 4
- Completed Activity : 4
- Percentage Completion : 11.4%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedul



Day 19
07/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 4
- Completed Activity : 4
- Percentage Completion :11.4%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 20
08/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 4
- Completed Activity : 4
- Percentage Completion : 11.4%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)




Day 21
09/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 4
- Completed Activity : 4
- Percentage Completion : 11.4%
- SPI – Scheduled Performance Index : 1.3
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)




Day 22
11/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 2
- Completed Activity : 4
- Percentage Completion : 11.4%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 23
12/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 2
- Completed Activity : 11
- Percentage Completion : 31.4%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 24
13/05/26
- Total Planned Activity : 35 nos
- Ongoing Activity : 2
- Completed Activity : 11
- Percentage Completion : 31.4%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 25
14/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 3
- Completed Activity : 12
- Percentage Completion : 33.3%
- SPI – Scheduled Performance Index : 0.26
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 26
15/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 3
- Completed Activity : 12
- Percentage Completion : 33.3%
- SPI – Scheduled Performance Index : 0.27
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 27
16/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 13
- Percentage Completion : 36.1%
- SPI – Scheduled Performance Index : 0.28
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 28
18/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 13
- Percentage Completion : 36.1%
- SPI – Scheduled Performance Index : 0.35
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)




Day 29
19/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 2
- Completed Activity : 13
- Percentage Completion : 36.1%
- SPI – Scheduled Performance Index : 0.36
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 30
20/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 2
- Completed Activity : 13
- Percentage Completion : 36.1%
- SPI – Scheduled Performance Index : 0.36
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 31
21/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 3
- Completed Activity : 14
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 32
22/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 3
- Completed Activity : 14
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 33
23/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.41
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 34
25/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.43
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 35
26/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.44
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 36
27/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.44
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 37
29/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 38
30/05/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 39
01/06/26
- Total Planned Activity : 36 nos
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.57
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 40
02.06.26
- Total Planned Activity : 36
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 39%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 41
03.06.26
- Total Planned Activity : 36
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion :39%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 42
04.06.26
- Total Planned Activity : 36
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 39%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 43
05.06.26
- Total Planned Activity : 36
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion :39%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 44
06.06.26
- Total Planned Activity : 36
- Ongoing Activity : 2
- Completed Activity :14
- Percentage Completion : 39%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 45
08.06.26
- Total Planned Activity : 36
- Ongoing Activity : 2
- Completed Activity : 14
- Percentage Completion : 39%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)
