Electricals

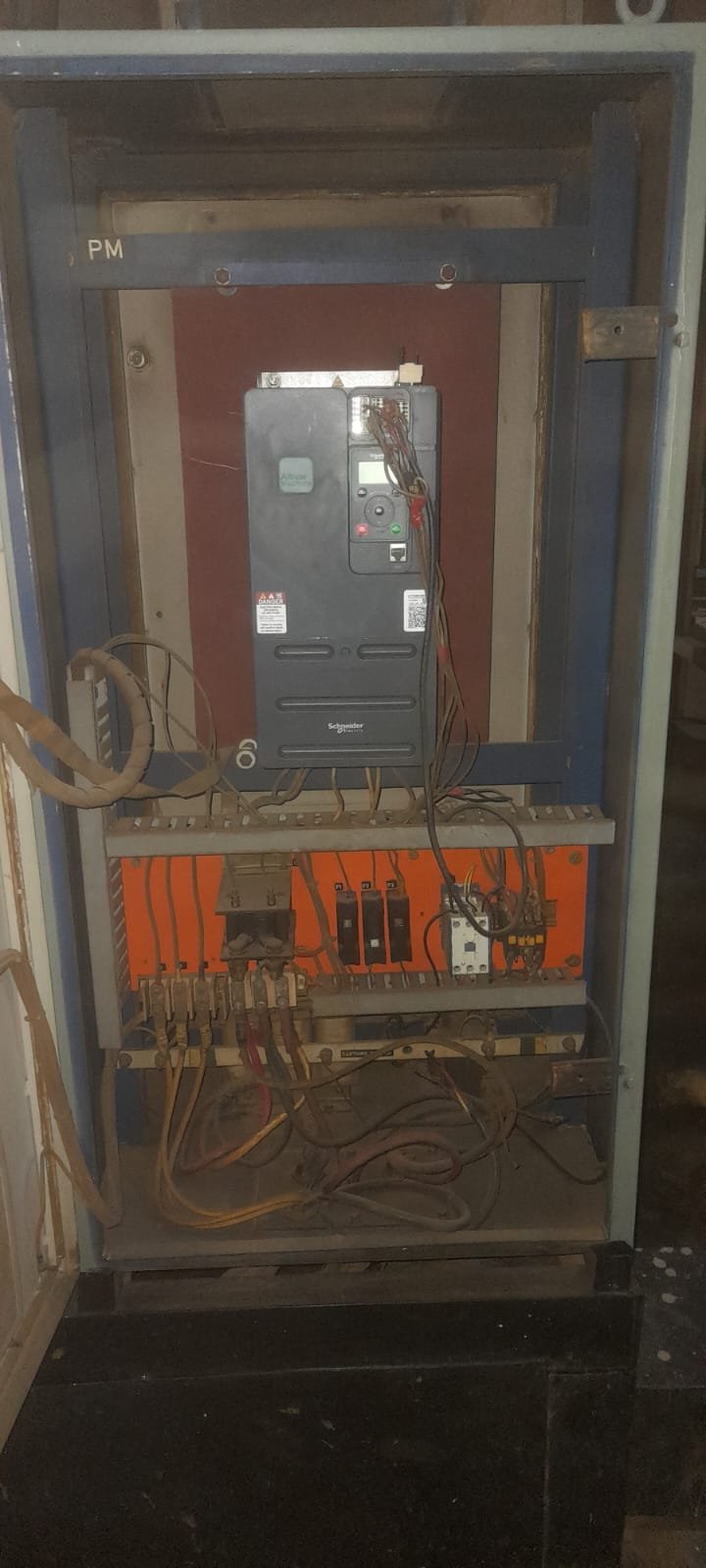

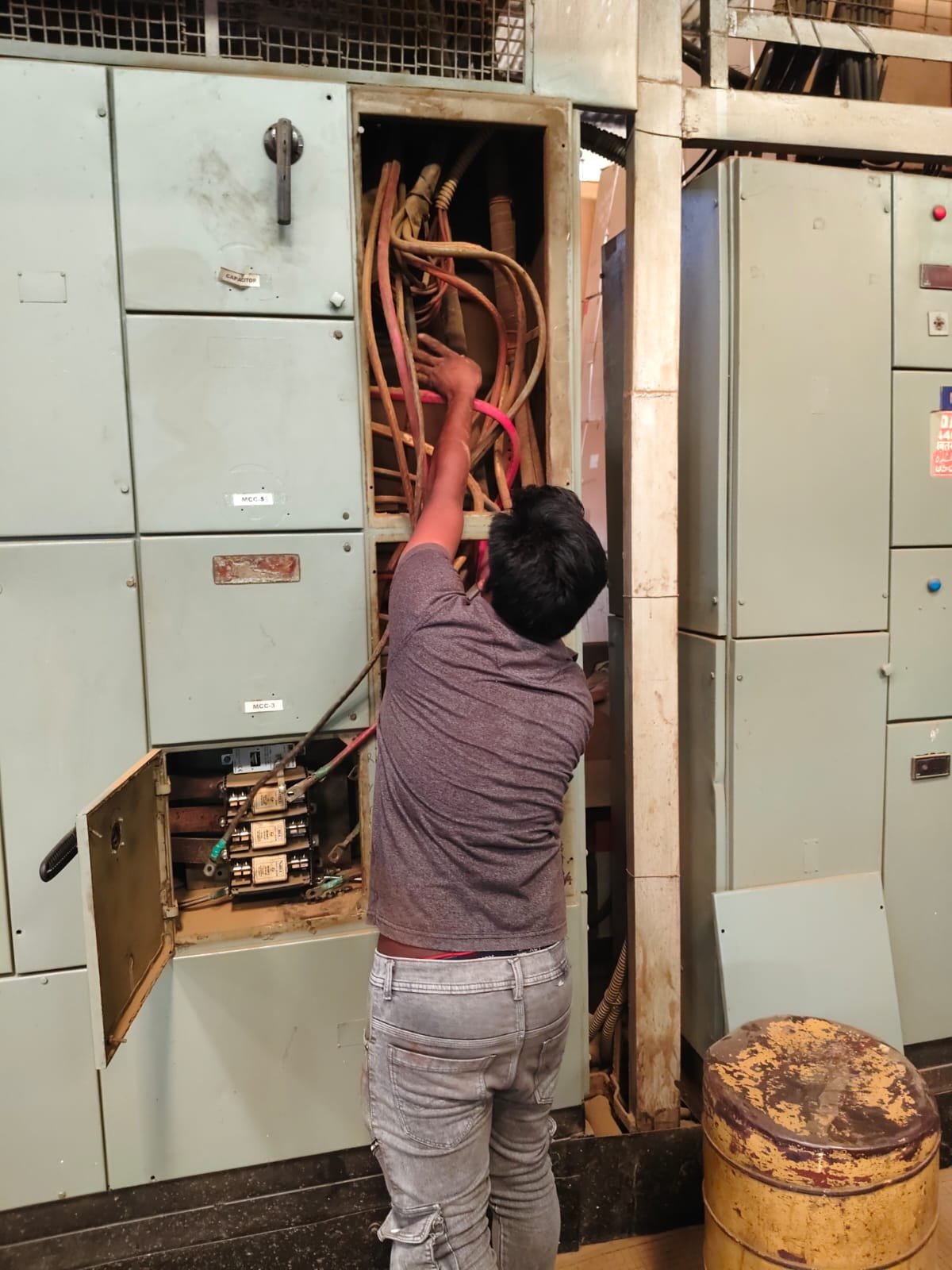

Comprehensive electrical works including cabling, panels, load distribution, and commissioning
Gantt Chart for Electricals
Day 01
16/04/2026
- Total Planned Activity : 23 nos
- Ongoing Activity : 2 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index :



Day 02
17/04/2026
- Total Planned Activity : 23 nos
- Ongoing Activity : 2 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index :



Day 03
18/04/2026
- Total Planned Activity : 23 nos
- Ongoing Activity : 2 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index :



Day 04
19/04/2026
- Total Planned Activity : 23 nos
- Ongoing Activity : 3 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index :



Day 05
20/04/2026
- Total Planned Activity : 23 nos
- Ongoing Activity : 2 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index :



Day 06
21/04/2026
- Total Planned Activity : 23 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 2
- Percentage Completion : 8.7%
- SPI – Scheduled Performance Index :



Day 07
22/04/2026
- Total Planned Activity : 23 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 3
- Percentage Completion : 13%
- SPI – Scheduled Performance Index : 1.0



Day 08
23/04/2026
- Total Planned Activity : 23 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 4
- Percentage Completion : 17.4%
- SPI – Scheduled Performance Index : 1.7



Day 09
24/04/2026
- Total Planned Activity : 23 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 4
- Percentage Completion : 17.4%
- SPI – Scheduled Performance Index : 2.2
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 10
25/04/2026
- Total Planned Activity : 26 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 4
- Percentage Completion : 15.4%
- SPI – Scheduled Performance Index : 2.1
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 11
27/04/2026
- Total Planned Activity : 26 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 6
- Percentage Completion : 23.1%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 12
28/04/2026
- Total Planned Activity : 26 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 6
- Percentage Completion : 23.1%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 13
29/04/26
- Total Planned Activity : 26 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 8
- Percentage Completion : 30.8%
- SPI – Scheduled Performance Index : 2.1
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 14
30/04/26
- Total Planned Activity : 26 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 8
- Percentage Completion : 30.8%
- SPI – Scheduled Performance Index : 2.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 15
02/05/26
- Total Planned Activity : 26 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 8
- Percentage Completion : 30.8%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 16
04/05/26
- Total Planned Activity : 26 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 8
- Percentage Completion : 30.8%
- SPI – Scheduled Performance Index : 1.7
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 17
05/05/26
- Total Planned Activity : 26 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 8
- Percentage Completion : 30.8%
- SPI – Scheduled Performance Index : 1.6
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 18
06/05/26
- Total Planned Activity : 28 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 8
- Percentage Completion : 28.6%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 19
07/05/26
- Total Planned Activity : 28 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 8
- Percentage Completion : 28.6%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 20
08/05/26
- Total Planned Activity : 28 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 8
- Percentage Completion : 28.6%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 21
09/05/26
- Total Planned Activity : 28 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 8
- Percentage Completion : 28.6%
- SPI – Scheduled Performance Index : 1.3
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 22
11/05/26
- Total Planned Activity : 28 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 11
- Percentage Completion : 39.3%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 23
12/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 11
- Percentage Completion : 36.7%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 24
13/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 11
- Percentage Completion : 36.7%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 25
14/05/26
- Total Planned Activity : 30nos
- Ongoing Activity : 2 Nos
- Completed Activity : 11
- Percentage Completion : 36.7%
- SPI – Scheduled Performance Index : 0.26
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 26
15/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 11
- Percentage Completion : 36.7%
- SPI – Scheduled Performance Index : 0.27
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 27
16/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 11
- Percentage Completion : 36.7%
- SPI – Scheduled Performance Index : 0.28
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 28
18/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 11
- Percentage Completion : 36.7%
- SPI – Scheduled Performance Index : 0.25
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 29
19/05/26
- Total Planned Activity : 30nos
- Ongoing Activity : 2 Nos
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.36
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 30
20/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.35
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 31
21/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 32
22/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 33
23/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.41
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 34
25/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.43
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 35
26/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.44
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 36
27/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.44
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 37
29/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 38
30/05/26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2
- Completed Activity : 22
- Percentage Completion : 73.3%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)




Day 39
01.06.26
- Total Planned Activity : 30 nos
- Ongoing Activity : 2
- Completed Activity : 21
- Percentage Completion : 70%
- SPI – Scheduled Performance Index : 0.57
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 40
16/04/2026 (Thursday)
- Total Planned Activity : 42 nos
- Ongoing Activity : 3 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index : 1.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 41
02.06.26
- Total Planned Activity : 32
- Ongoing Activity : 2
- Completed Activity : 29
- Percentage Completion : 66%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 42
03.06.26
- Total Planned Activity : 32
- Ongoing Activity : 2
- Completed Activity :29
- Percentage Completion : 66%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 43
04.06.26
- Total Planned Activity : 32
- Ongoing Activity : 2
- Completed Activity : 29
- Percentage Completion : 66%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 44
05.06.26
- Total Planned Activity : 32
- Ongoing Activity : 2
- Completed Activity :29
- Percentage Completion :66
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 45
06.06.26
- Total Planned Activity : 32
- Ongoing Activity : 2
- Completed Activity : 29
- Percentage Completion : 66%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)
