Thrushing
Upgrading threshing capacity with advanced design to achieve higher throughput, better recovery, and process stability.
Gantt Chart for Thrushing
Day 01
16/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 2 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index :
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 02
17/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 2 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index :
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 03
18/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 2 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index :
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 04
19/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 4 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index :
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 05
20/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity :
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index : 1.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 06
21/04/2026
- Total Planned Activity : 63nos
- Ongoing Activity :6 Nos
- Completed Activity : 13
- Percentage Completion : 20.6%
- SPI – Scheduled Performance Index : 1.7
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 07
22/04/2026
- Total Planned Activity : 63nos
- Ongoing Activity :6 Nos
- Completed Activity : 13
- Percentage Completion : 20.6%
- SPI – Scheduled Performance Index : 1.7
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 08
23/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 6 Nos
- Completed Activity : 15
- Percentage Completion : 23.8%
- SPI – Scheduled Performance Index : 1.7
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 09
24/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 4 Nos
- Completed Activity : 19
- Percentage Completion : 30.2%
- SPI – Scheduled Performance Index : 2.2
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 10
25/04/2026
- Total Planned Activity : 42 nos
- Ongoing Activity : 6 Nos
- Completed Activity : 19
- Percentage Completion : 30.2%
- SPI – Scheduled Performance Index : 2.1
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 11
27/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 8 Nos
- Completed Activity : 21
- Percentage Completion : 33.3%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 12
28/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 6 Nos
- Completed Activity : 17
- Percentage Completion : 29%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 13
29/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 4 Nos
- Completed Activity : 24
- Percentage Completion : 38.1%
- SPI – Scheduled Performance Index : 2.1
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 14
30/04/2026
- Total Planned Activity : 63 nos
- Ongoing Activity : 4 Nos
- Completed Activity : 24
- Percentage Completion : 38.1%
- SPI – Scheduled Performance Index : 2.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 15
01/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 4
- Completed Activity : 24
- Percentage Completion : 38.1%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 16
02/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 13 Nos
- Completed Activity : 26
- Percentage Completion : 41.3%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 17
04/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 13
- Completed Activity : 26
- Percentage Completion : 41.3%
- SPI – Scheduled Performance Index : 1.7
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 18
05/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 7
- Completed Activity : 26
- Percentage Completion : 41.3%
- SPI – Scheduled Performance Index : 1.6
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 19
06/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 7 Nos
- Completed Activity : 26
- Percentage Completion : 41.3%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 20
07/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 7 Nos
- Completed Activity : 26
- Percentage Completion : 41.3%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 21
08/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 7
- Completed Activity : 26
- Percentage Completion : 41.3%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 22
09/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 7
- Completed Activity : 26
- Percentage Completion : 41.3%
- SPI – Scheduled Performance Index : 1.3
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 23
11/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 10
- Completed Activity : 32
- Percentage Completion : 50.8%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 24
12/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 10
- Completed Activity : 32
- Percentage Completion : 50.8%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 25
13/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 10
- Completed Activity : 32
- Percentage Completion : 50.8%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 26
14/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion : 42.9%
- SPI – Scheduled Performance Index : 0.26
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 27
15/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion :42.9%
- SPI – Scheduled Performance Index : 0.27
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 28
16/05/26
- Total Planned Activity : 42 nos
- Ongoing Activity : 8 Nos
- Completed Activity : 27
- Percentage Completion : 42.9%
- SPI – Scheduled Performance Index : 0.28
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 29
18/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8 Nos
- Completed Activity : 27
- Percentage Completion : 42.9%
- SPI – Scheduled Performance Index : 0.35
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 30
19/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8 Nos
- Completed Activity : 27
- Percentage Completion : 42.9%
- SPI – Scheduled Performance Index : 0.36
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 31
20/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion : 42.9%
- SPI – Scheduled Performance Index : 0.36
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 32
21/05/26
- Total Planned Activity :63 nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion : 43%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 33
22/05/265
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion : 43%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 34
23/05/26
- Total Planned Activity : 63nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion : 43%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 35
25/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion :43%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 36
26/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion : 43%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 37
27/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion : 42.9%
- SPI – Scheduled Performance Index : 0.44
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 38
29/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 12
- Percentage Completion : 42.9%
- SPI – Scheduled Performance Index : 0.44
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 39
30/05/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 27
- Percentage Completion : 42.9%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 40
01/06/26
- Total Planned Activity : 63 nos
- Ongoing Activity : 8
- Completed Activity : 46
- Percentage Completion : 73%
- SPI – Scheduled Performance Index : 0.57
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 41
02.06.26
- Total Planned Activity : 63
- Ongoing Activity : 20
- Completed Activity : 46
- Percentage Completion : 73%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 42
03.06.2026
- Total Planned Activity :60
- Ongoing Activity : 20
- Completed Activity : 46
- Percentage Completion : 73%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 43
04.06.2026
- Total Planned Activity : 63
- Ongoing Activity : 20
- Completed Activity :46
- Percentage Completion : 73%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 44
05.06.2026
- Total Planned Activity : 63
- Ongoing Activity :20
- Completed Activity : 46
- Percentage Completion : 73%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

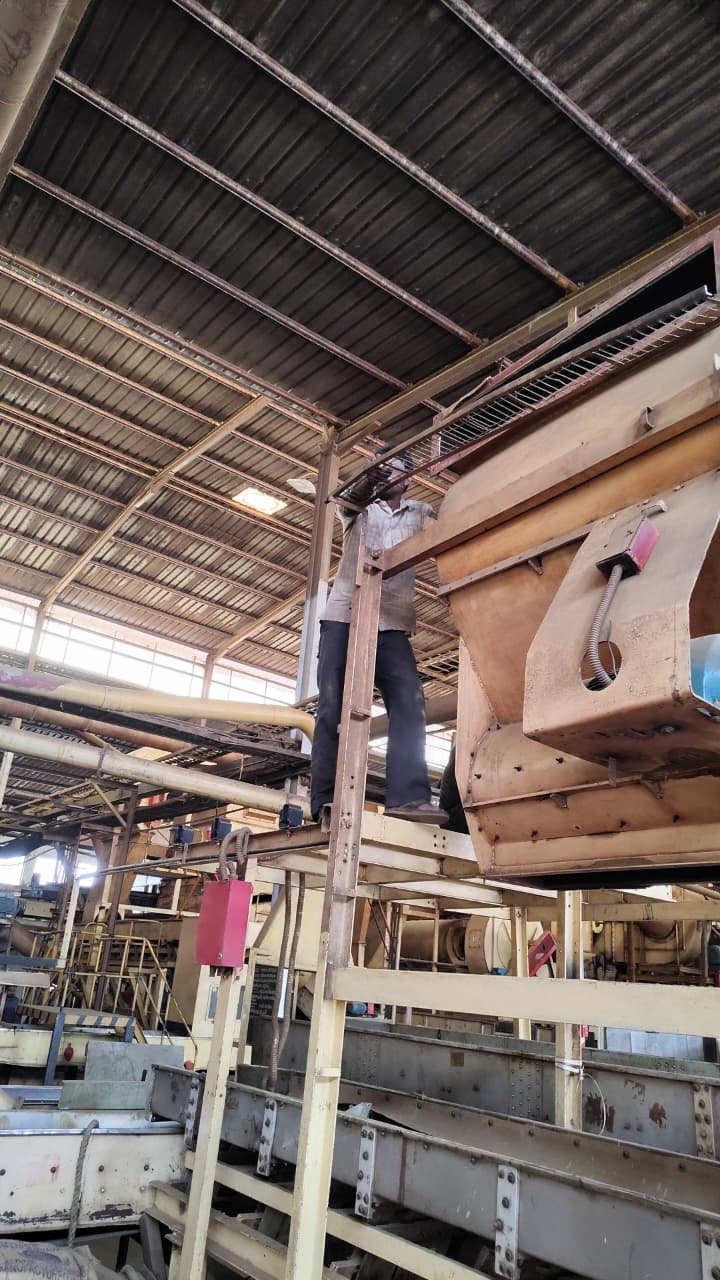

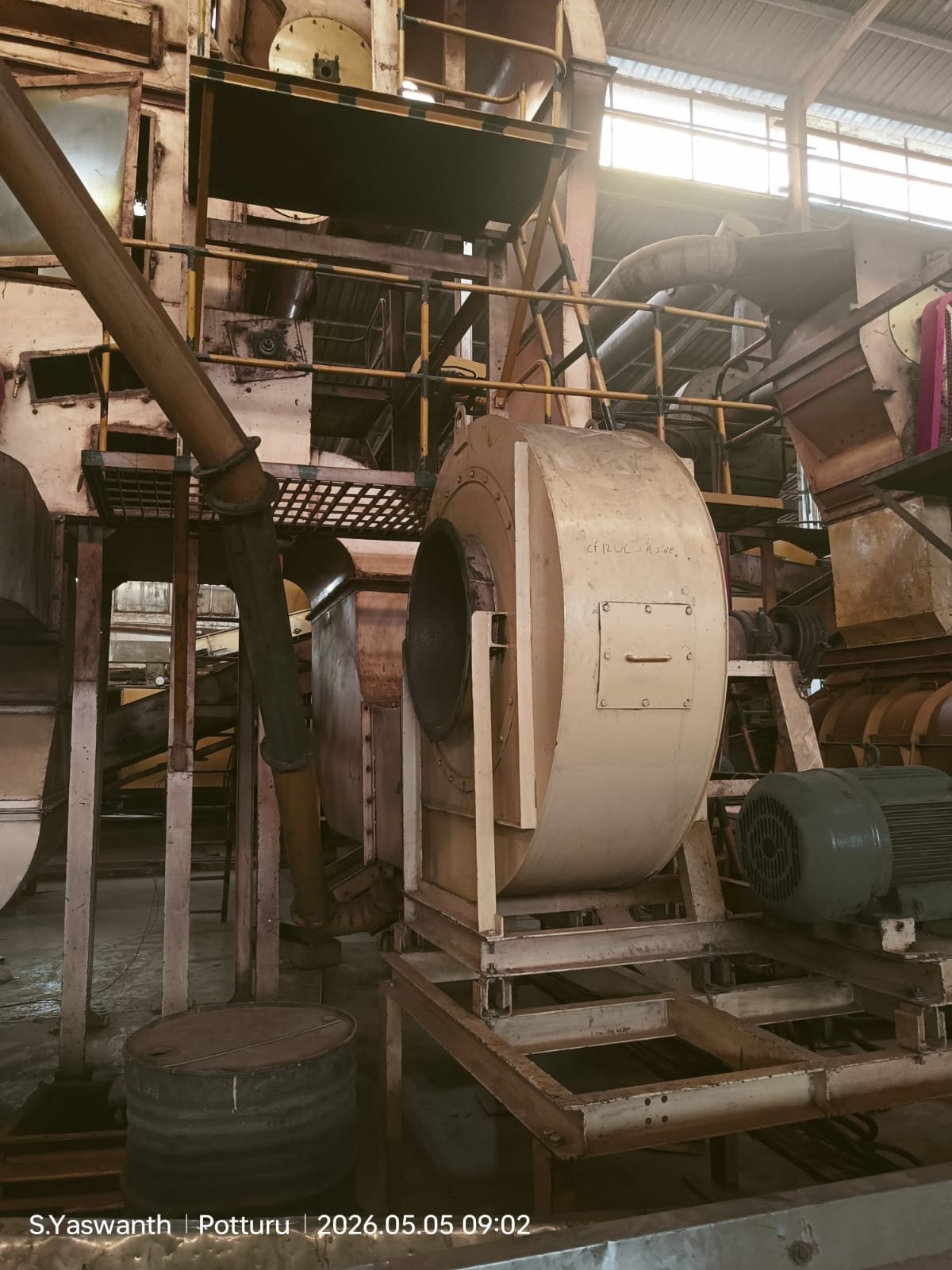

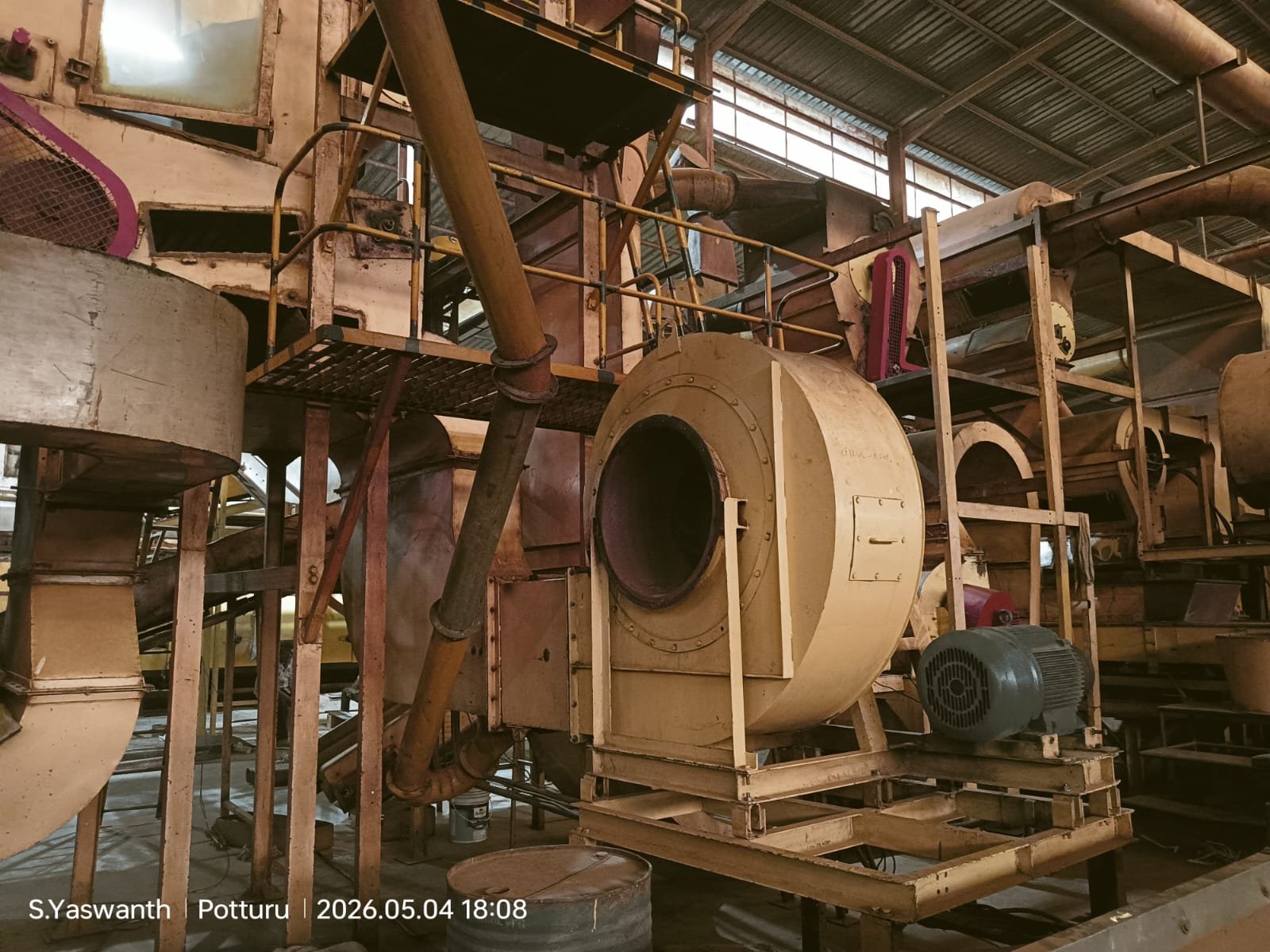

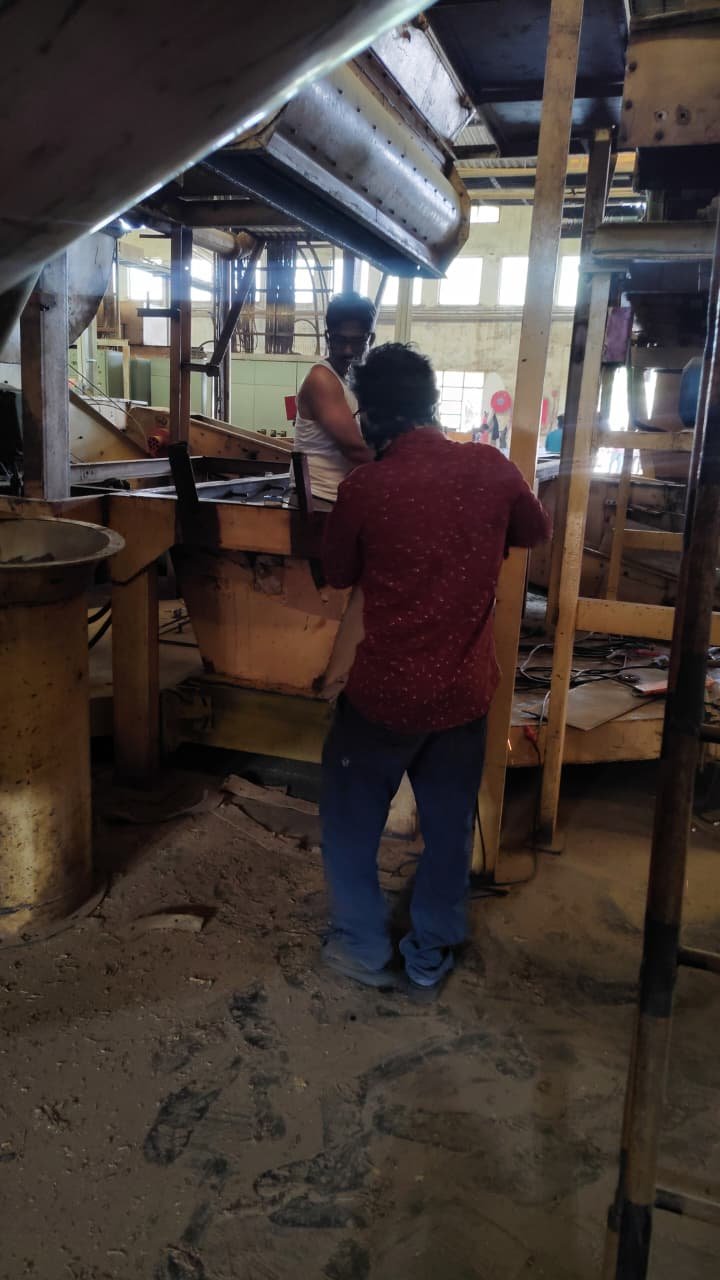

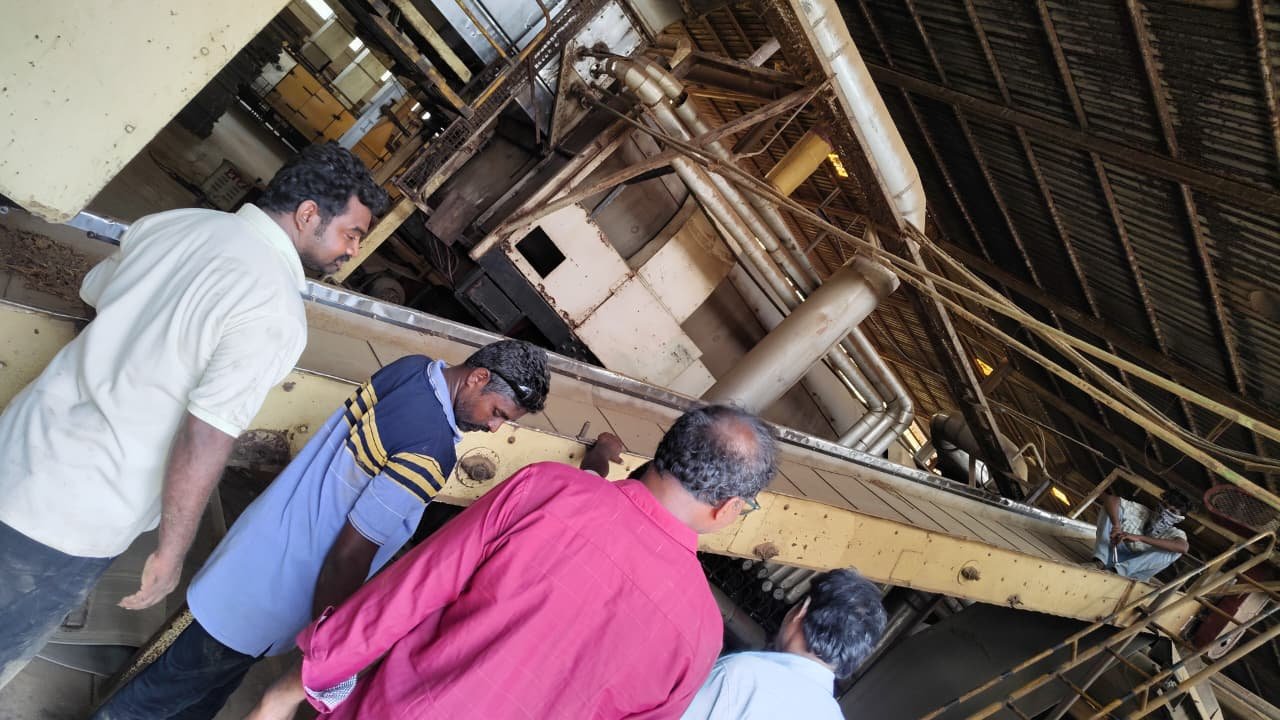

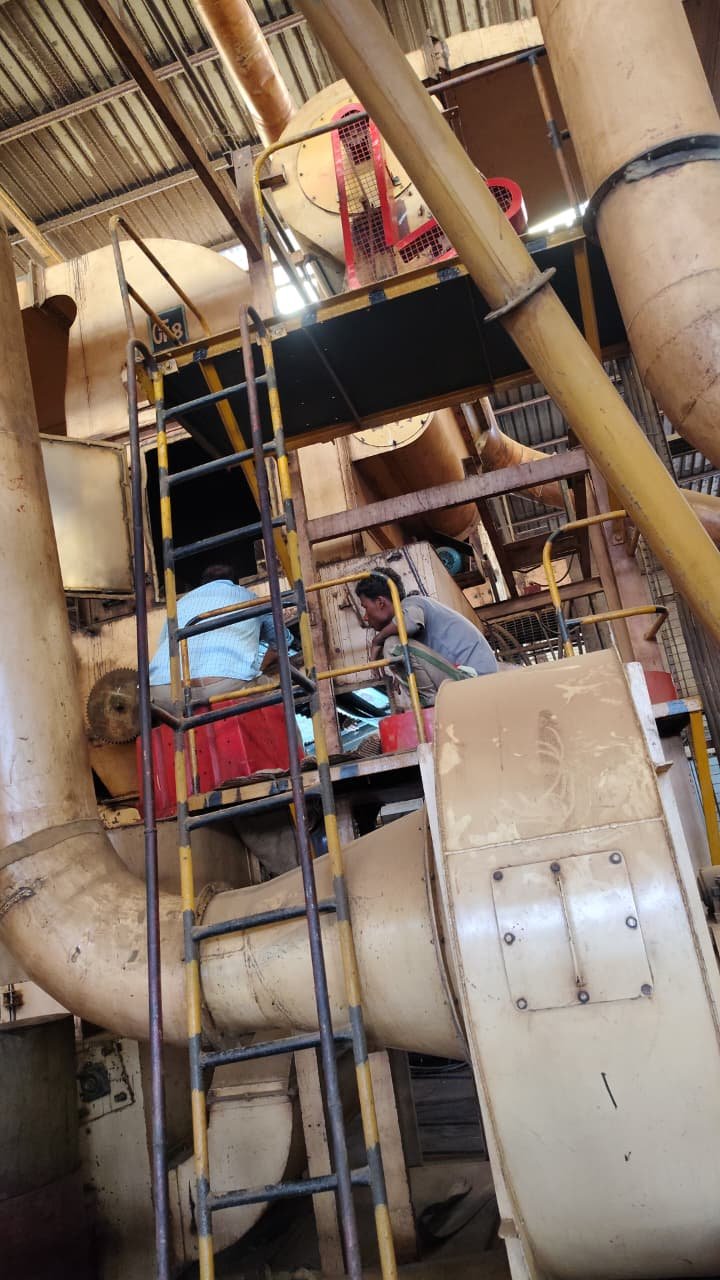

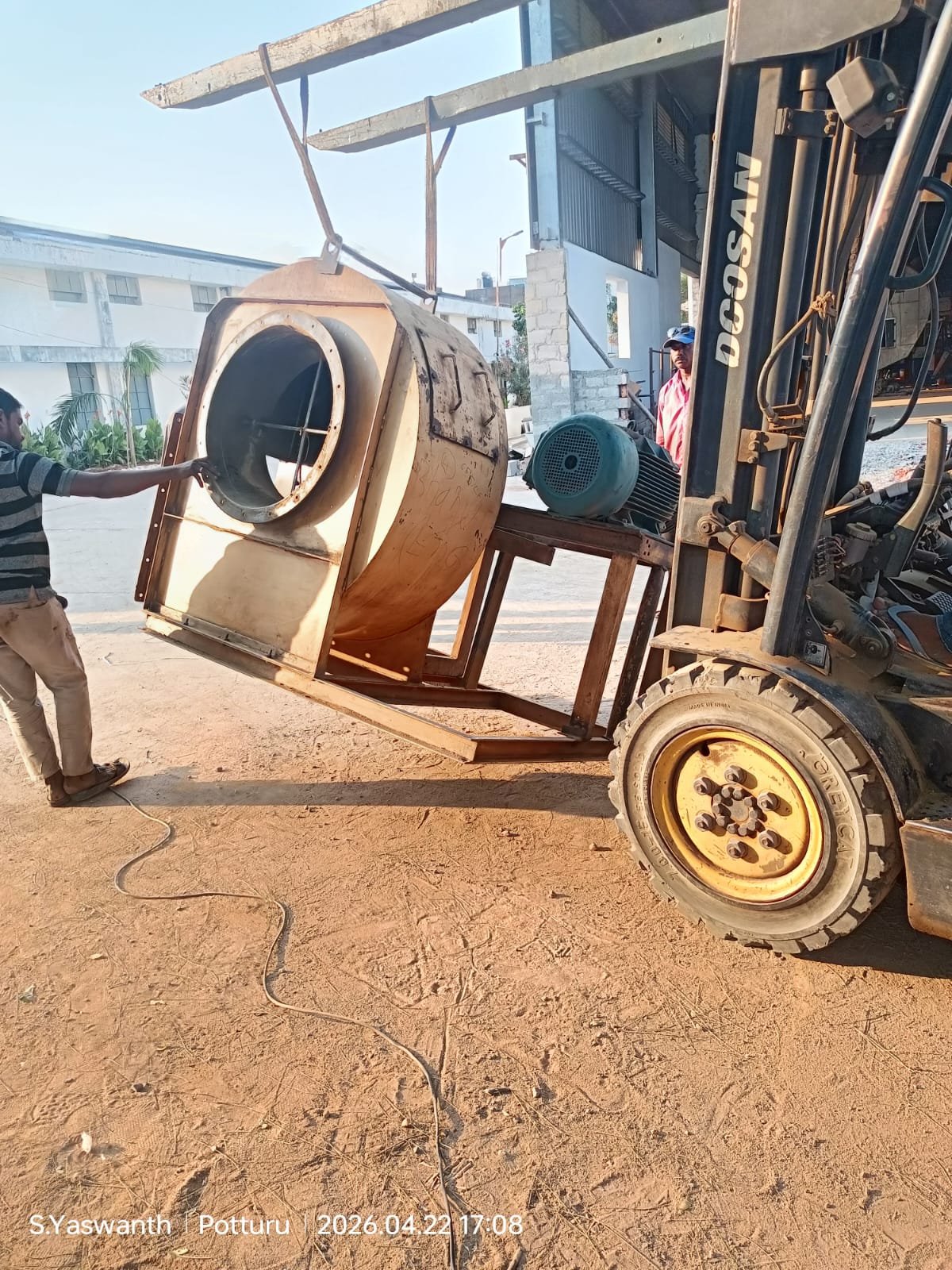

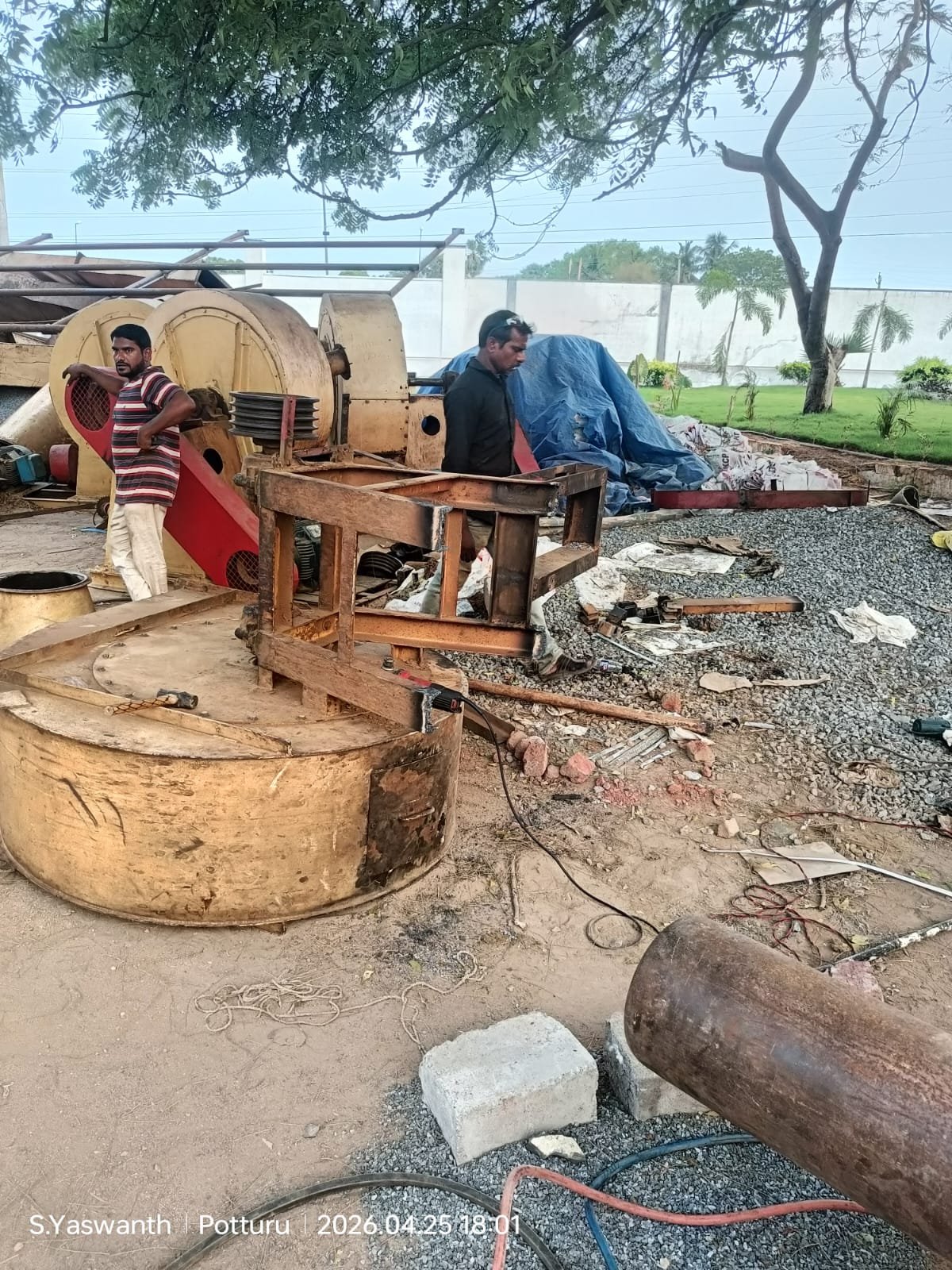

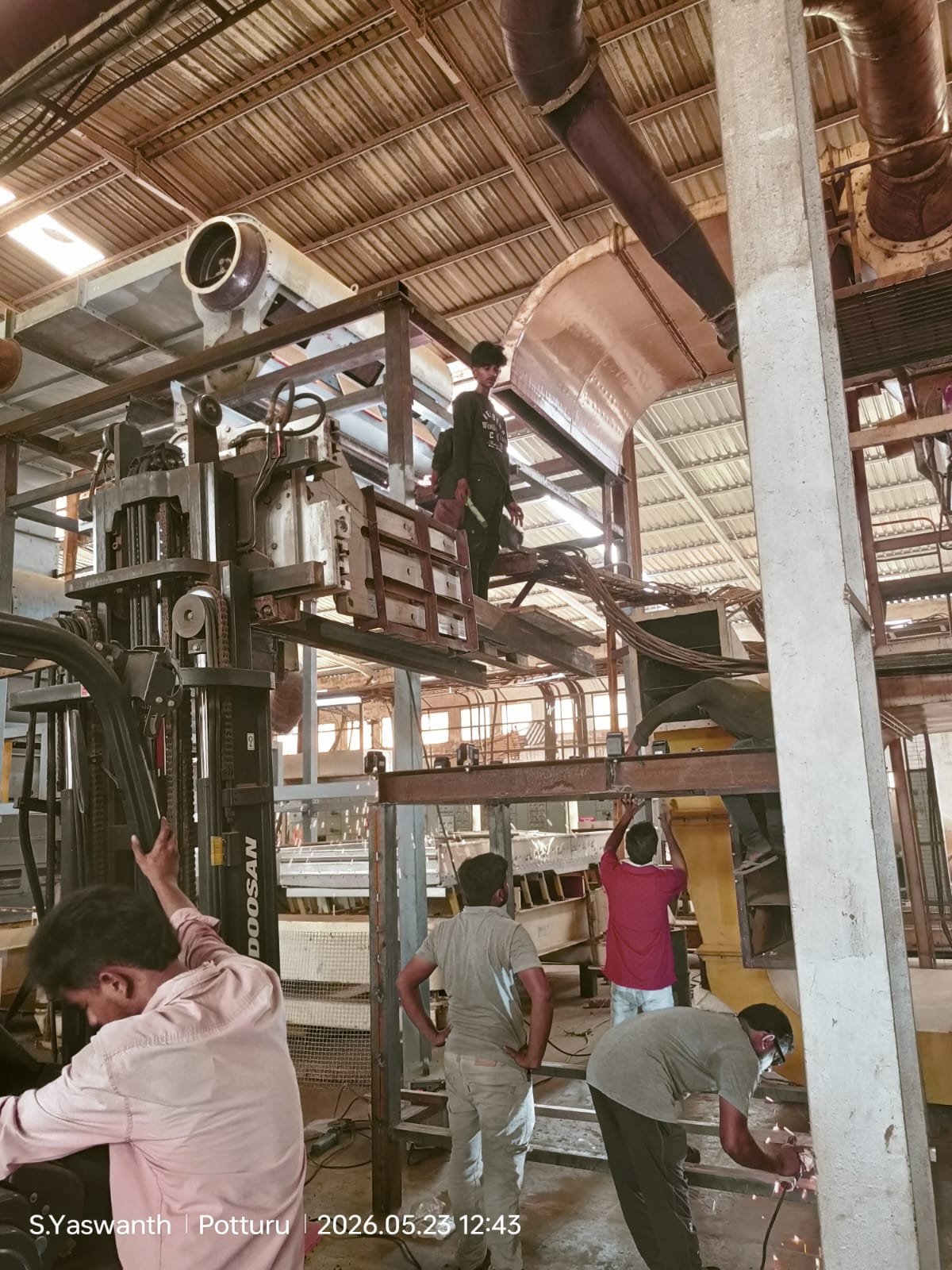

Day 45
06.06.26
- Total Planned Activity : 63
- Ongoing Activity : 20
- Completed Activity :46
- Percentage Completion : 73%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)
