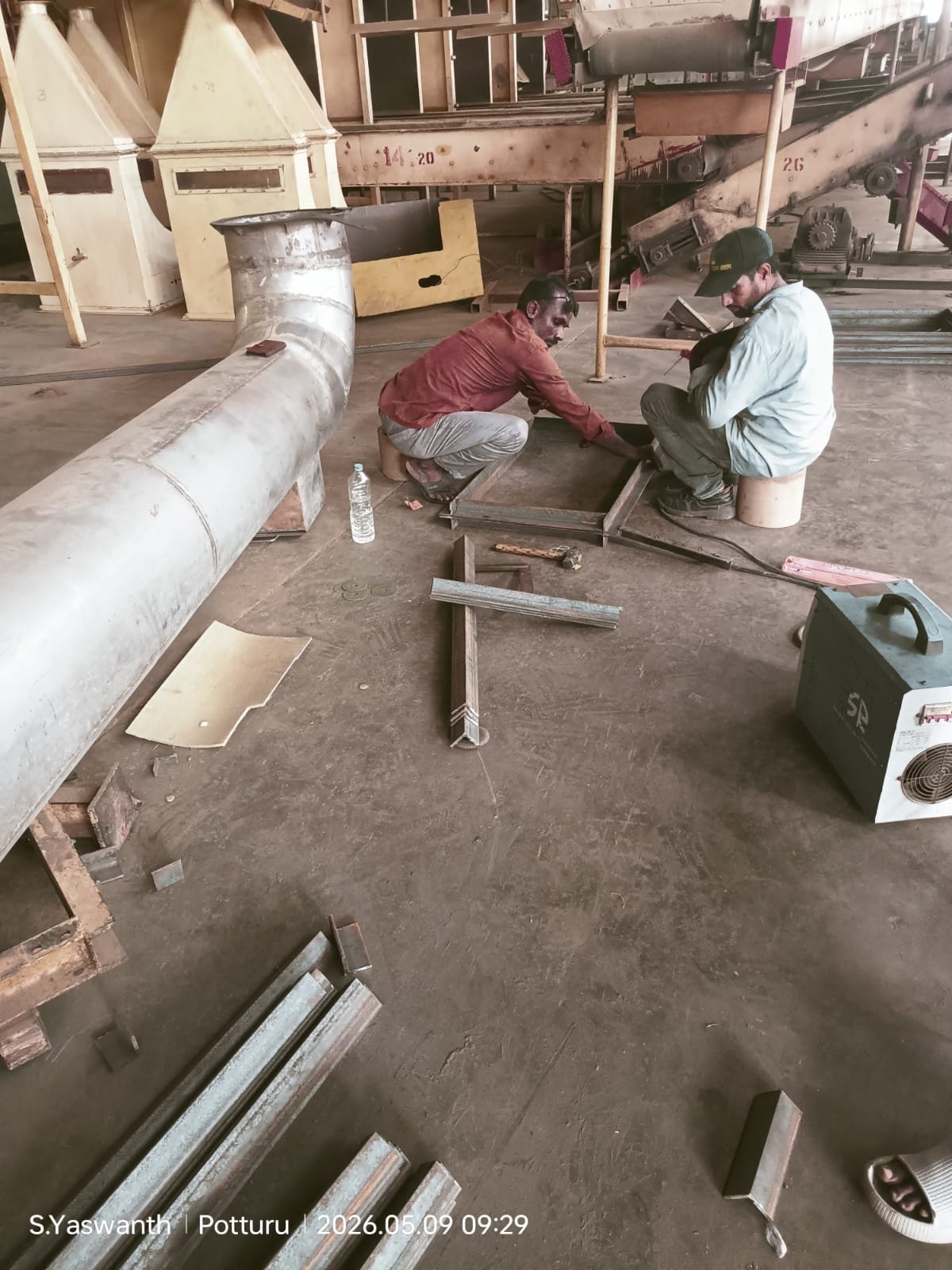

Tipps Line

Optimizing tipping and initial material handling for smooth flow, reduced losses, and consistent feed quality.

Gantt Chart for Tipps Line

Day 01

16/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 1 Nos
  • Completed Activity : Nil
  • Percentage Completion : 0%
  • SPI – Scheduled Performance Index :

17/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 1 Nos
  • Completed Activity : Nil
  • Percentage Completion : 0%
  • SPI – Scheduled Performance Index

18/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 2 Nos
  • Completed Activity : Nil
  • Percentage Completion : 0%
  • SPI – Scheduled Performance Index : 1.0

19/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 2 Nos
  • Completed Activity : Nil
  • Percentage Completion : 0%
  • SPI – Scheduled Performance Index : 1.0

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

20/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 0
  • Completed Activity : Nil
  • Percentage Completion : 0%
  • SPI – Scheduled Performance Index : 1.0

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

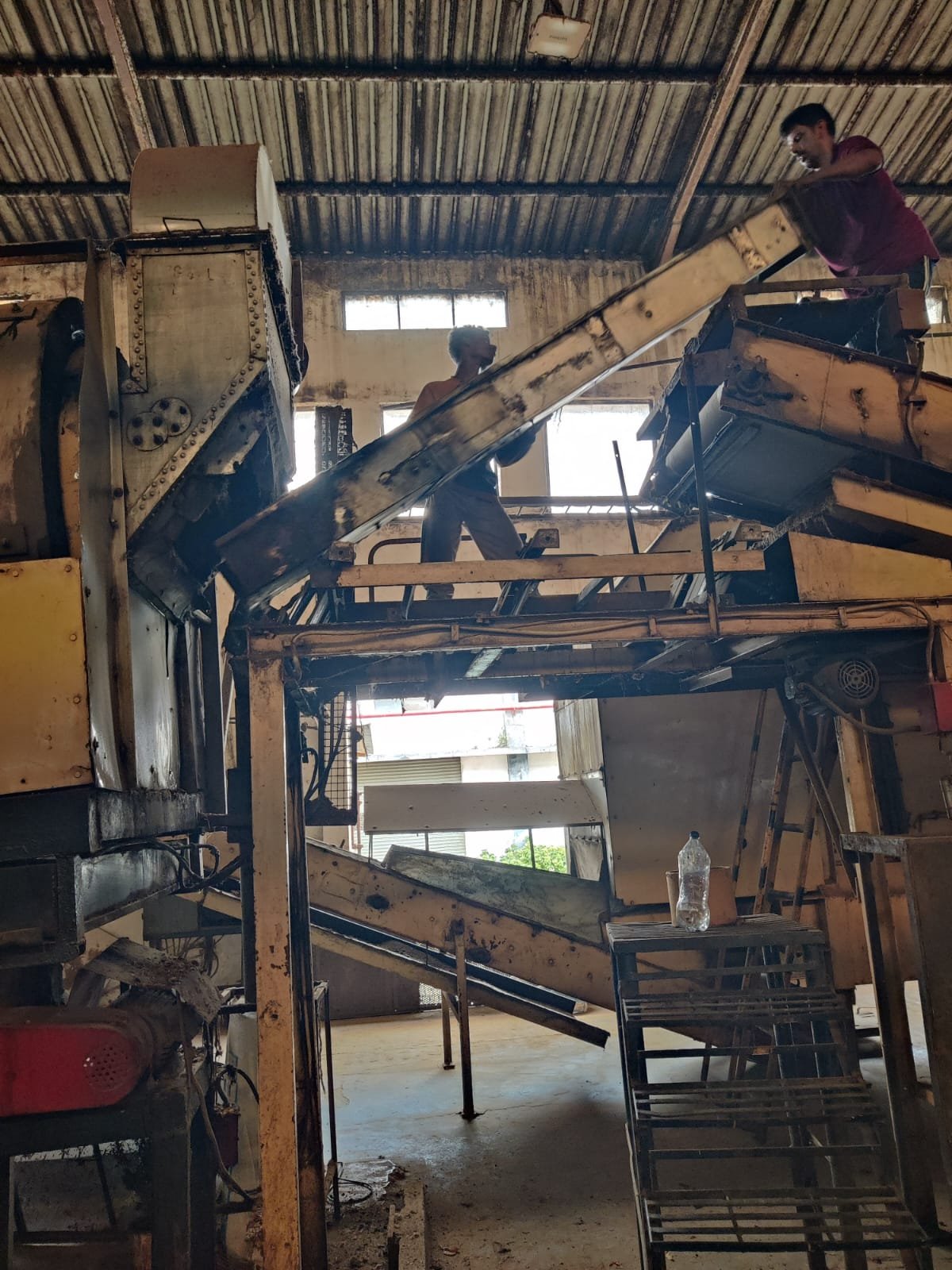

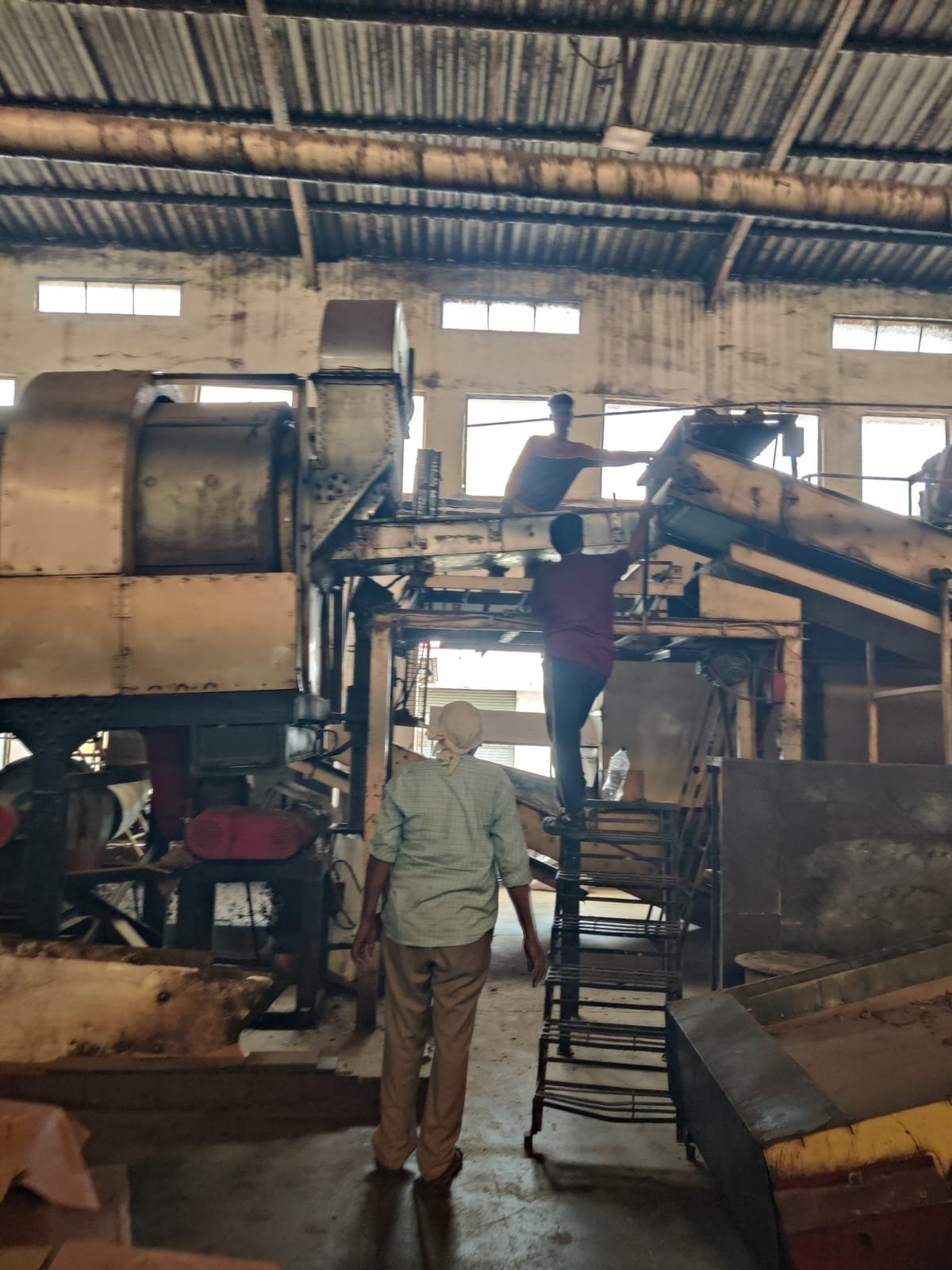

21/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 0 Nos
  • Completed Activity : 1
  • Percentage Completion : 0%
  • SPI – Scheduled Performance Index : 1.7

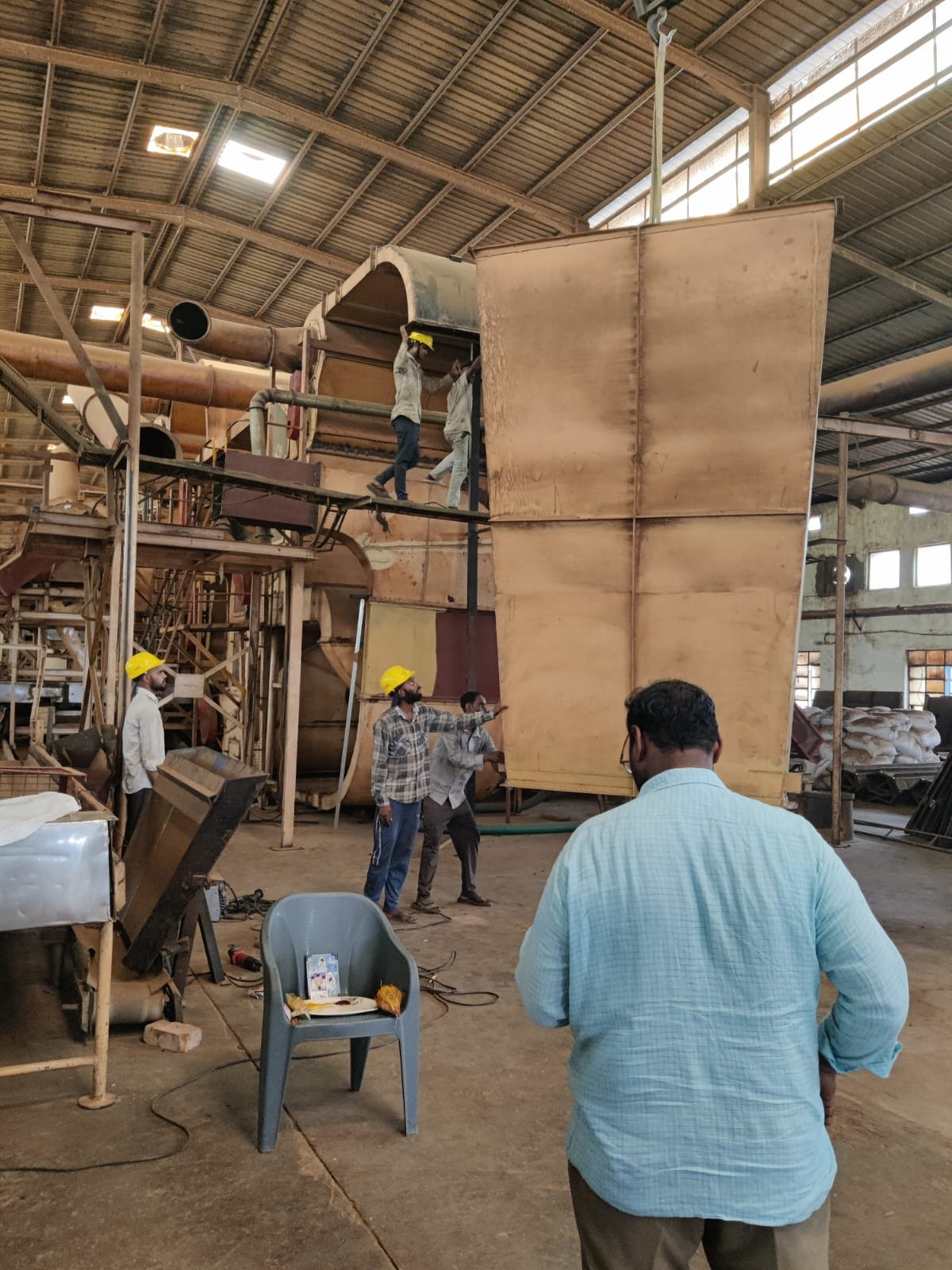

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

22/04/2026

  • Total Planned Activity : 20nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 1
  • Percentage Completion : 0%
  • SPI – Scheduled Performance Index : 1.5

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

23/04/2026

  • Total Planned Activity : 20nos
  • Ongoing Activity : 6 Nos
  • Completed Activity : 2
  • Percentage Completion : 10%
  • SPI – Scheduled Performance Index : 1.7

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

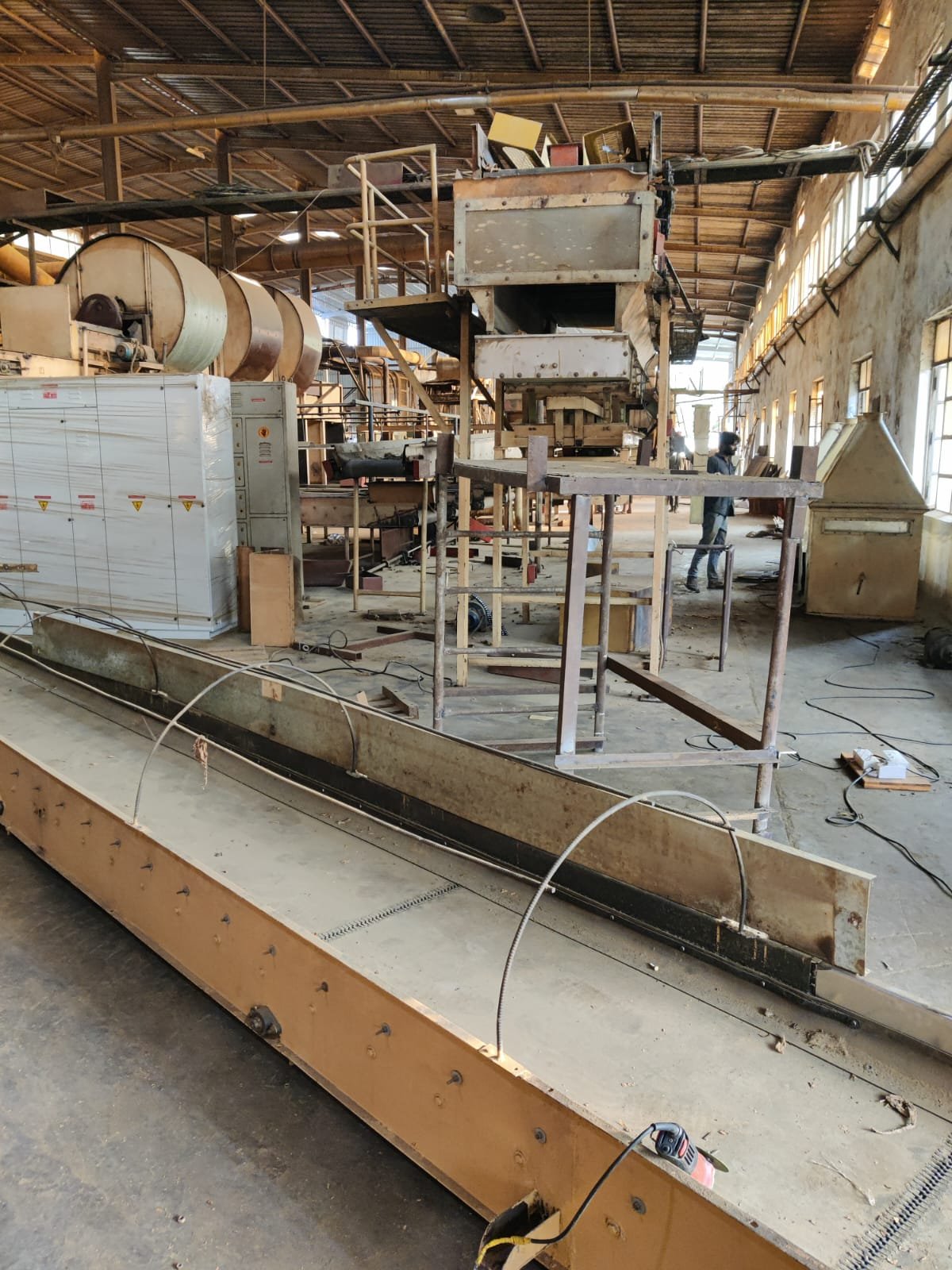

24/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 6 Nos
  • Completed Activity : 4
  • Percentage Completion : 0%
  • SPI – Scheduled Performance Index : 1.9

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

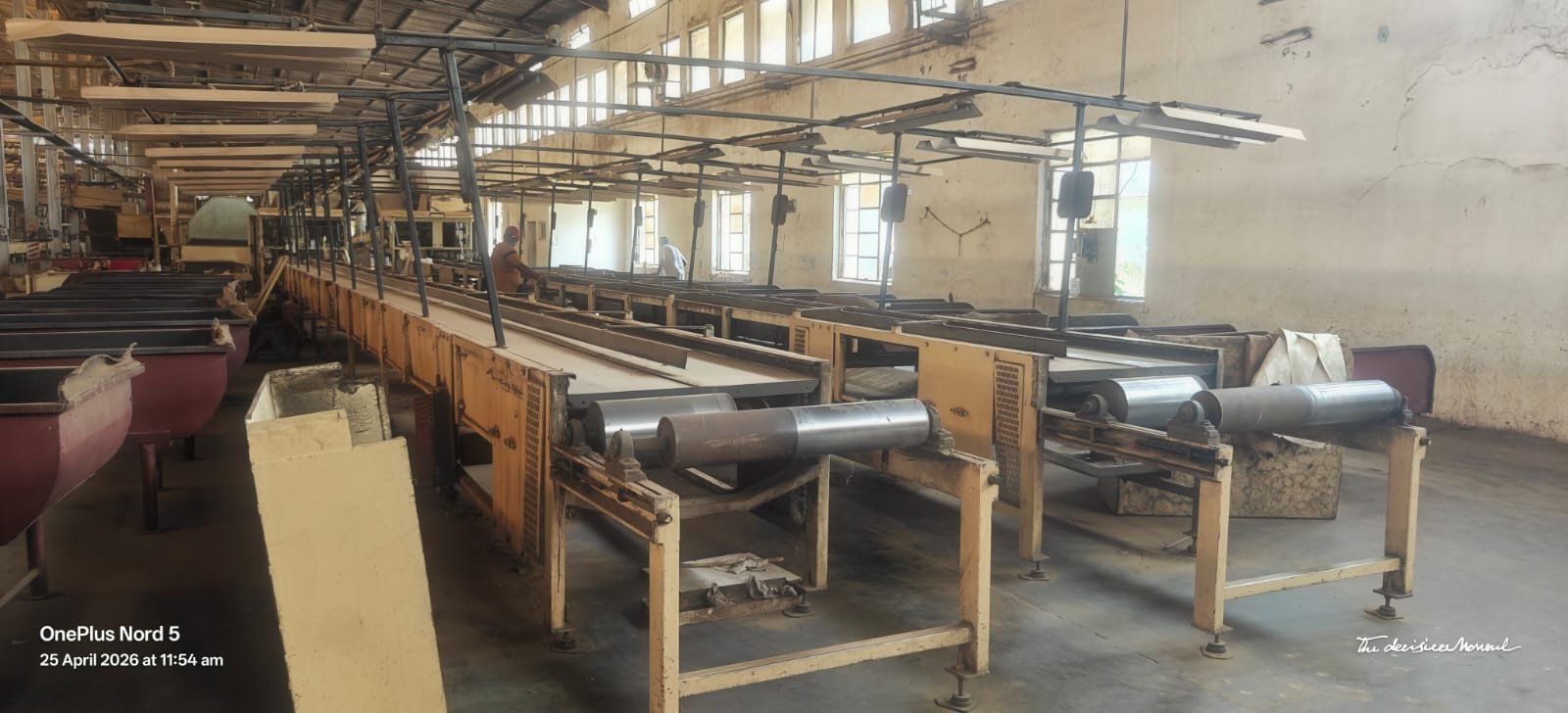

25/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 4
  • Percentage Completion : 20%
  • SPI – Scheduled Performance Index : 2.1

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

27/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 6 Nos
  • Completed Activity : 6
  • Percentage Completion : 30%
  • SPI – Scheduled Performance Index : 1.9

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

28/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 8
  • Percentage Completion : 40%
  • SPI – Scheduled Performance Index : 1.9

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

29/04/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 8
  • Percentage Completion : 40%
  • SPI – Scheduled Performance Index : 2.1

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

30/04/2026

  • Total Planned Activity :  20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 8
  • Percentage Completion : 40%
  • SPI – Scheduled Performance Index : 2.0

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

02/05/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity :9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.9

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

03/05/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.8

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

04/05/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.7

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

05/05/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.6

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

06/05/2026

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.5

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

07/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity :4 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.5

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

08/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.4

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

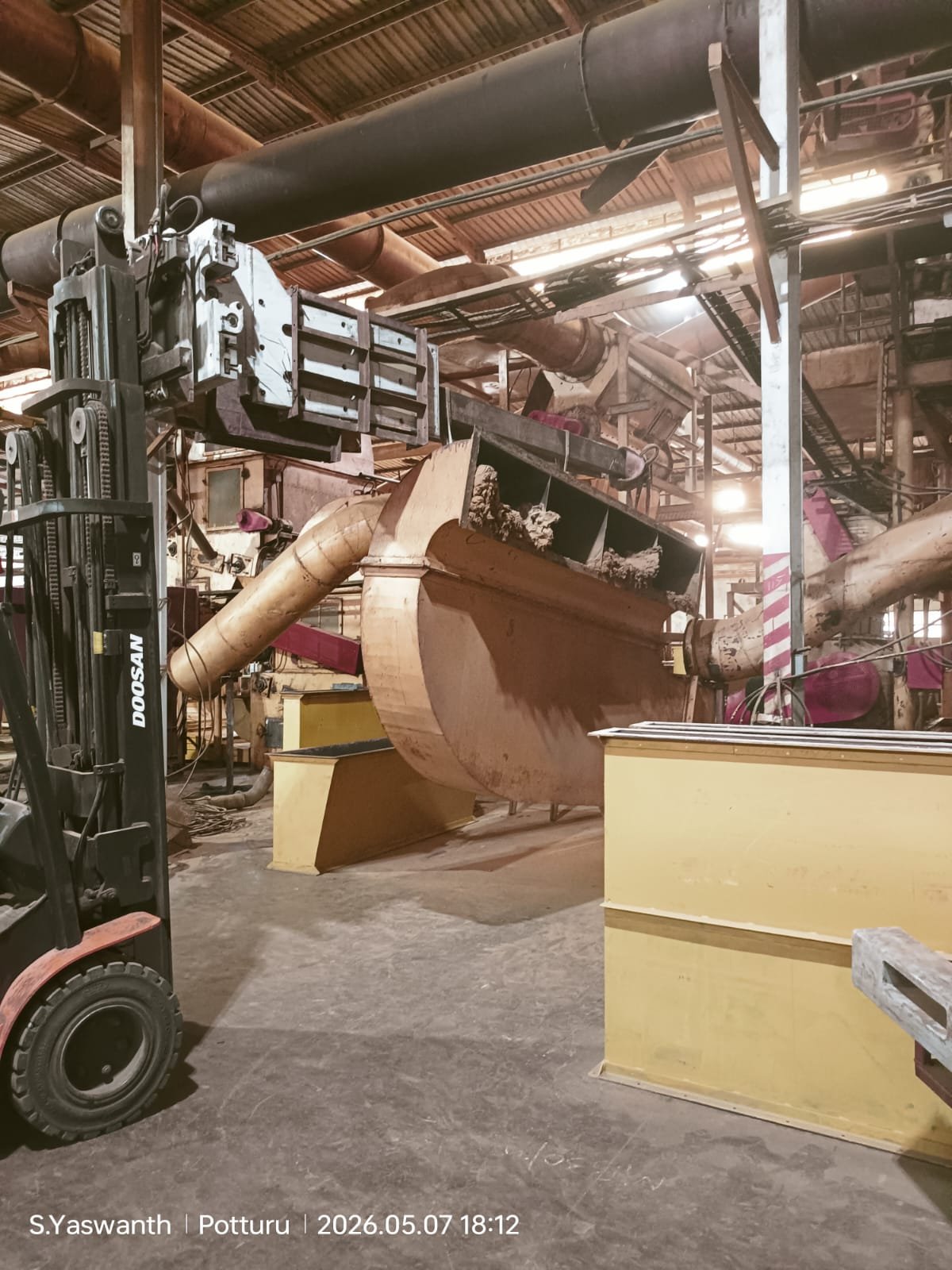

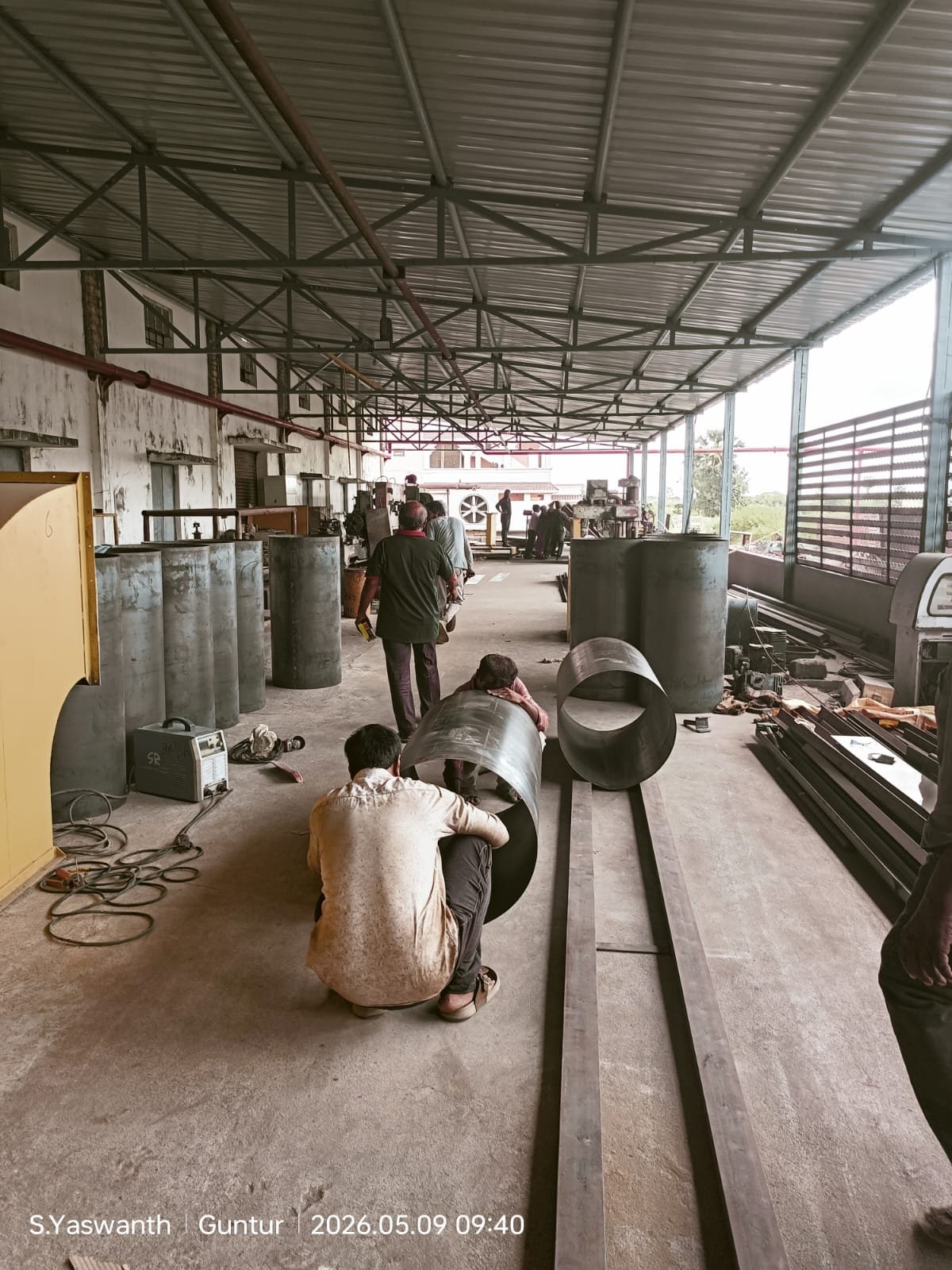

09/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.3

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

11/05/26

  • Total Planned Activity :20 nos
  • Ongoing Activity : 6 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.4

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

12/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 6 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.5

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

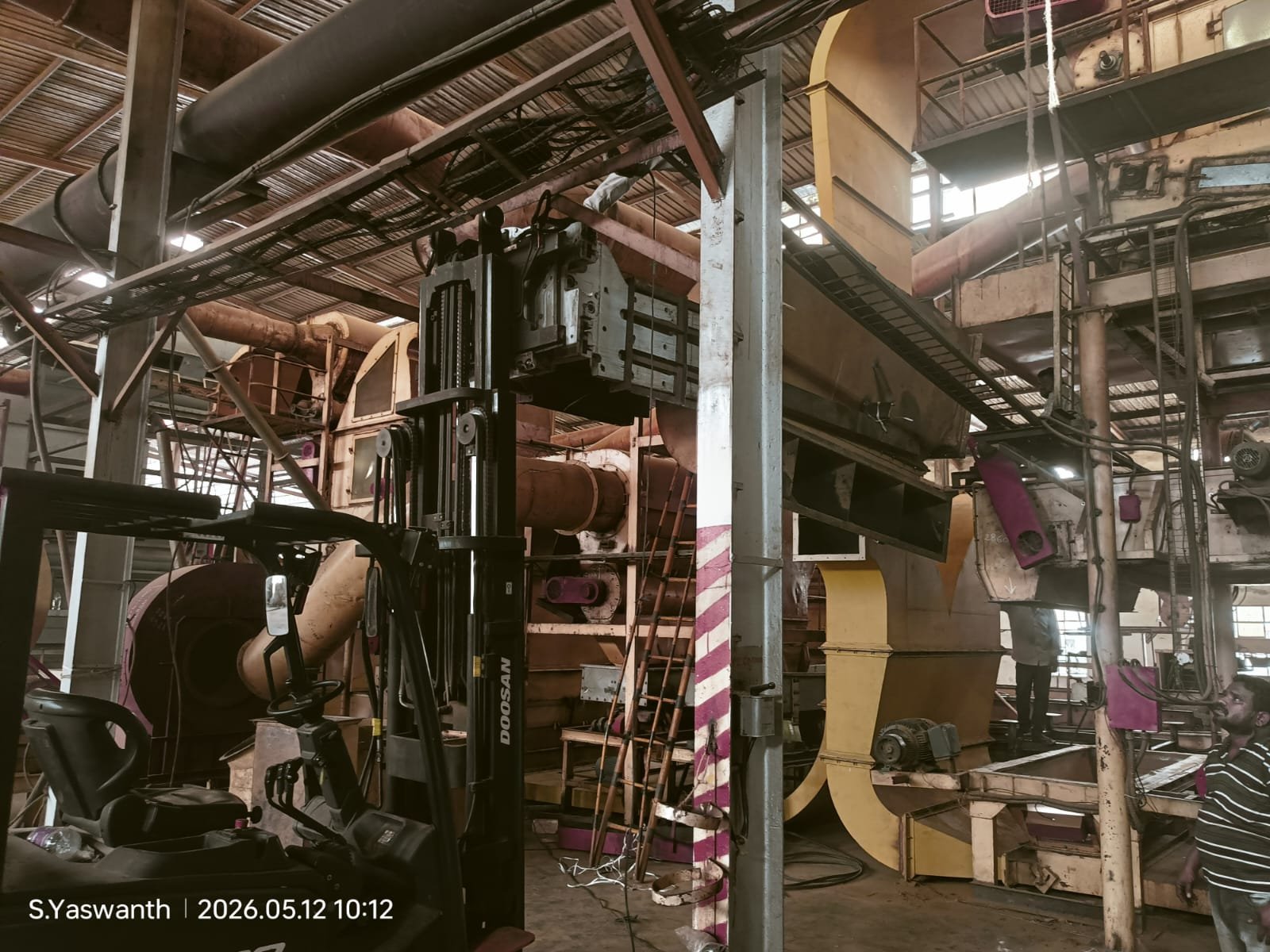

13/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 6 Nos
  • Completed Activity : 9
  • Percentage Completion : 45%
  • SPI – Scheduled Performance Index : 1.4

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

14/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 5 Nos
  • Completed Activity : 10
  • Percentage Completion : 50%
  • SPI – Scheduled Performance Index : 0.26

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

15/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 5 Nos
  • Completed Activity : 10
  • Percentage Completion : 50%
  • SPI – Scheduled Performance Index : 0.27

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

16/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 5 Nos
  • Completed Activity : 10
  • Percentage Completion : 50%
  • SPI – Scheduled Performance Index : 0.28

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

18/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4 Nos
  • Completed Activity : 10
  • Percentage Completion : 50%
  • SPI – Scheduled Performance Index : 0.35

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

19/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 10
  • Percentage Completion : 50%
  • SPI – Scheduled Performance Index : 1.0

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

20/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 10
  • Percentage Completion : 50%
  • SPI – Scheduled Performance Index : 0.36

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

21/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 11
  • Percentage Completion : 55%
  • SPI – Scheduled Performance Index :0.40

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

22/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 11
  • Percentage Completion : 55%
  • SPI – Scheduled Performance Index : 0.40

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

23/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 11
  • Percentage Completion :55%
  • SPI – Scheduled Performance Index : 0.40

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

25/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 11
  • Percentage Completion :55%
  • SPI – Scheduled Performance Index : 0.40

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

26/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 11
  • Percentage Completion : 55%
  • SPI – Scheduled Performance Index : 0.40

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

27/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 12
  • Percentage Completion : 60%
  • SPI – Scheduled Performance Index : 0.44

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

29/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 12
  • Percentage Completion : 60%
  • SPI – Scheduled Performance Index : 0.44

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

30/05/26

  • Total Planned Activity : 20 nos
  • Ongoing Activity : 4
  • Completed Activity : 12
  • Percentage Completion : 60%
  • SPI – Scheduled Performance Index : 0.47

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

01/06/26

  • Total Planned Activity : 20nos
  • Ongoing Activity : 4
  • Completed Activity : 14
  • Percentage Completion : 70%
  • SPI – Scheduled Performance Index : 0.57

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

02/06/26

  • Total Planned Activity :20 nos
  • Ongoing Activity : 3
  • Completed Activity : 17
  • Percentage Completion : 70%
  • SPI – Scheduled Performance Index : 0.44

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

03/06/26

  • Total Planned Activity : 20nos
  • Ongoing Activity : 3
  • Completed Activity : 17
  • Percentage Completion : 70%
  • SPI – Scheduled Performance Index : 0.43

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

04/06/26

  • Total Planned Activity : 20
  • Ongoing Activity : 3
  • Completed Activity :17
  • Percentage Completion : 85
  • SPI – Scheduled Performance Index : 0.62

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

05/06/26

  • Total Planned Activity : 20
  • Ongoing Activity : 3 Nos
  • Completed Activity : 17
  • Percentage Completion : 85
  • SPI – Scheduled Performance Index : 0.62

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

06/06/26

  • Total Planned Activity : 20
  • Ongoing Activity : 3 Nos
  • Completed Activity : 17
  • Percentage Completion : 85%
  • SPI – Scheduled Performance Index : 0.62

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)

06/06/26

  • Total Planned Activity : 20
  • Ongoing Activity : 3 Nos
  • Completed Activity : 17
  • Percentage Completion : 85%
  • SPI – Scheduled Performance Index : 0.62

If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)
