SRD & Stem Complex
Improving stem drying efficiency and process control through optimized equipment layout and enhanced automation integration.
Gantt Chart for SRD & Stem Complex
Day 01
16/04/2026 (Thursday)

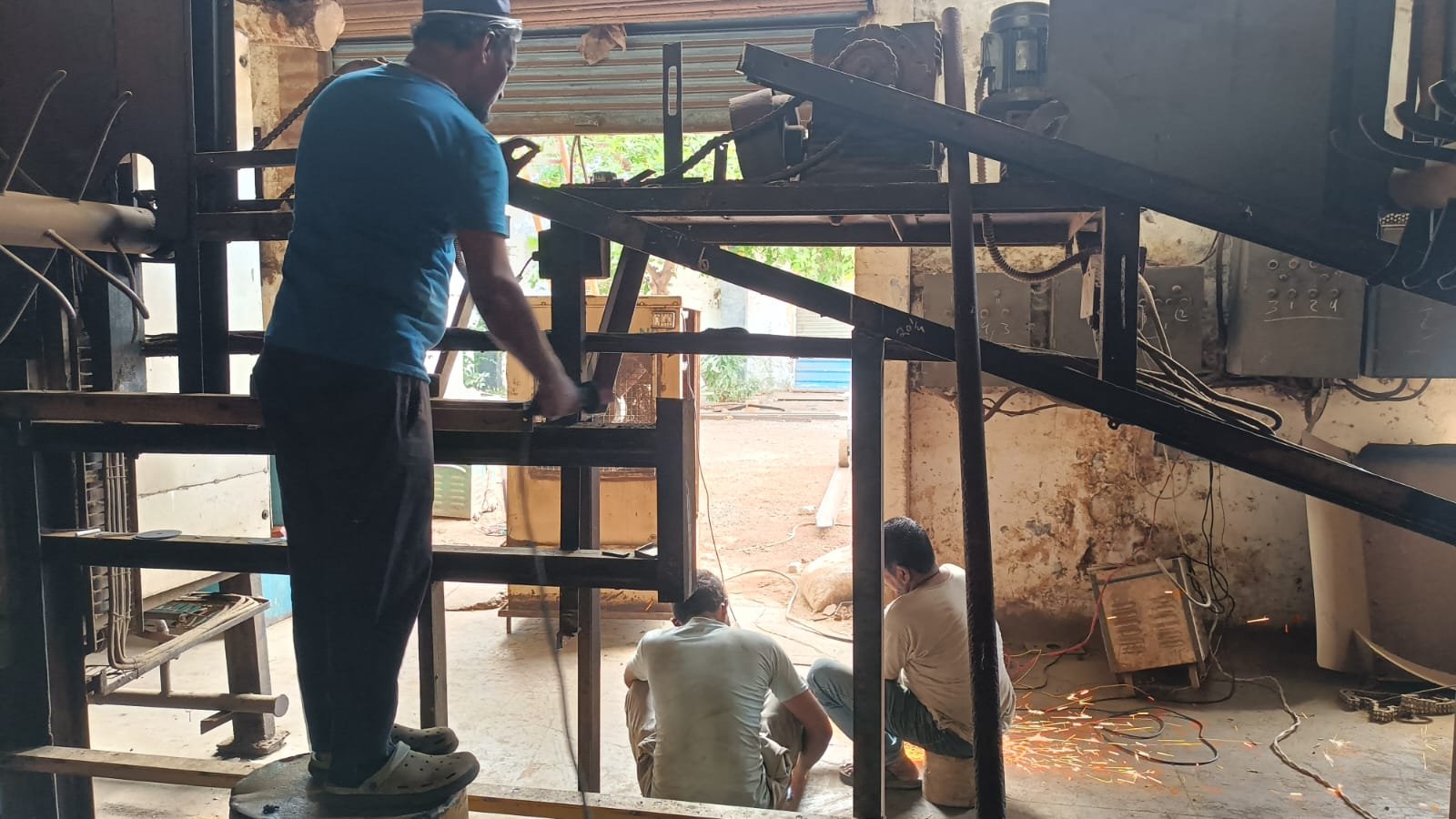

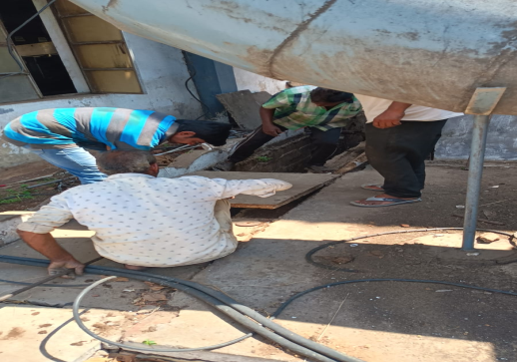

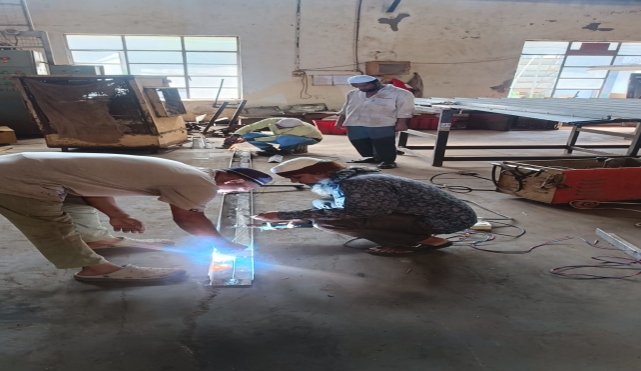

Stem Dryer Doors 16 No’s Removing Work. Stem Dryer Cooler Duct Removing. Stem complex Bleed Line Ducts Removing.



Day 02
17/04/2026

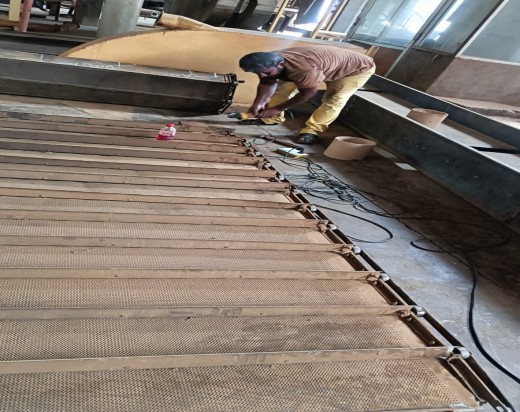

Stem Dryer Front Face Conveyors Supports Dismateling .Stem Dryer Apron Removing.(Total 212 Repers 8’11″/9″ Size)



Day 03
18/04/2026
Strem Coplex Duct Removing.Stem Vibrator 3&4 Shifting. Total Stem Complex Structers And Jackeys With 200 Channel Fixed Under Legs.



Day 04
21/04/2026
Stem Thins Fan With Saperator Shifting Stem Vib 1 & 2 Delivery Conveyor Shifting Fan Ducts Shfiting Small Stair Case & Supports Shifting Works Done Bt Crane.



Day 05
22/04/2026
Stem Main Lifting Fan Shifting. Total Stem Complex Platform Shifting.


Day 06
23/04/2026
| Stem Redryer Moment 60′ Feet Forward From Its Existing Position.Stem Press & Power Pack Shifting From Its Existing Position. |



Day 07
24/04/2026
- Total Planned Activity : 18 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 1
- Percentage Completion : 5.6%
- SPI – Scheduled Performance Index : 2.2


Day 08
25/04/2026
- Total Planned Activity : 18 nos
- Ongoing Activity : 1Nos
- Completed Activity : 2
- Percentage Completion : 11.1%
- SPI – Scheduled Performance Index : 2.1


Day 09
27/04/2026
- Total Planned Activity : 18 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 2
- Percentage Completion : 11.1%
- SPI – Scheduled Performance Index : 1.9


Day 10
28/04/2026
- Total Planned Activity : 18 nos
- Ongoing Activity : 4 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 11
29/04/2026
- Total Planned Activity : 18 nos
- Ongoing Activity : 4 Nos
- Completed Activity : 3
- Percentage Completion :16.7%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 12
30/04/2026
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 2.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 13
01/05/2026
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 14
02/04/2026
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 15
04/04/2026
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 1.7
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 16
05/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 1.6
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 17
06/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 18
07/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 19
08/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 20
09/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 3
- Percentage Completion : 16.7%
- SPI – Scheduled Performance Index : 1.3
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 21
11/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 1
- Completed Activity : 4
- Percentage Completion : 22.2%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 22
12/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 3 Nos
- Completed Activity : 4
- Percentage Completion : 22.2%
- SPI – Scheduled Performance Index : 1.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 23
13/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 1
- Completed Activity : 4
- Percentage Completion : 22.2%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 24
14/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 2
- Completed Activity : 7
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 1.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 25
15/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 2
- Completed Activity : 7
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 0.27
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 26
16/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 2
- Completed Activity : 7
- Percentage Completion : 38.9%
- SPI – Scheduled Performance Index : 1.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 27
18/05/26
- Total Planned Activity : 18nos
- Ongoing Activity : 0
- Completed Activity : 9
- Percentage Completion :50.0%
- SPI – Scheduled Performance Index : 0.35
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 28
19/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 1
- Completed Activity : 9
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.34
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 29
20/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 1
- Completed Activity : 9
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.36
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 30
21/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 1
- Completed Activity : 9
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 31
22/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 1
- Completed Activity : 9
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 32
23/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 1
- Completed Activity : 5
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 33
25/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 1
- Completed Activity : 5
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 34
26/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 1
- Completed Activity : 6
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 35
27/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 2
- Completed Activity : 9
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.44
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 36
29/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 2
- Completed Activity : 9
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 37
30/05/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 2
- Completed Activity : 9
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 38
01/06/26
- Total Planned Activity : 18 nos
- Ongoing Activity : 2
- Completed Activity : 9
- Percentage Completion : 50%
- SPI – Scheduled Performance Index : 0.57
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 39
02.06.2026
- Total Planned Activity : 15
- Ongoing Activity : 2
- Completed Activity :9
- Percentage Completion : 60%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 40
03.06.26
- Total Planned Activity : 15
- Ongoing Activity : 2
- Completed Activity : 9
- Percentage Completion : 60%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 41
04.06.2026
- Total Planned Activity :15
- Ongoing Activity : 2
- Completed Activity : 9
- Percentage Completion :60%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 42
05.06.26
- Total Planned Activity : 15
- Ongoing Activity : 2
- Completed Activity : 9
- Percentage Completion : 60%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 43
06.06.26
- Total Planned Activity :15
- Ongoing Activity : 2
- Completed Activity : 9
- Percentage Completion : 60%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 44
08.06.26
- Total Planned Activity : 15
- Ongoing Activity : 3
- Completed Activity : 9
- Percentage Completion : 60%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 45
16/04/2026 (Thursday)
- Total Planned Activity : 42 nos
- Ongoing Activity : 3 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index : 1.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)
