LRD & Packing
Strengthening lamina drying and packing systems to ensure quality consistency, higher output, and reliable operations.
Gantt Chart for LRD & Packing
Day 01
16/04/2026 (Thursday)

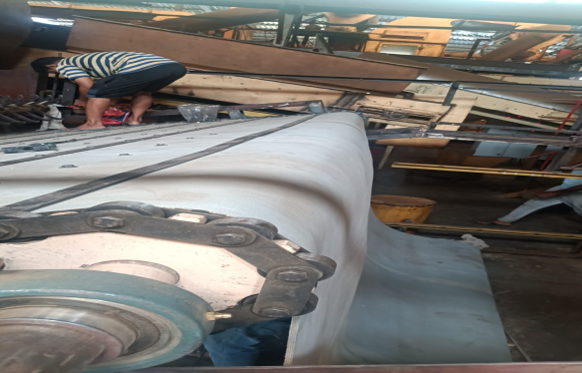

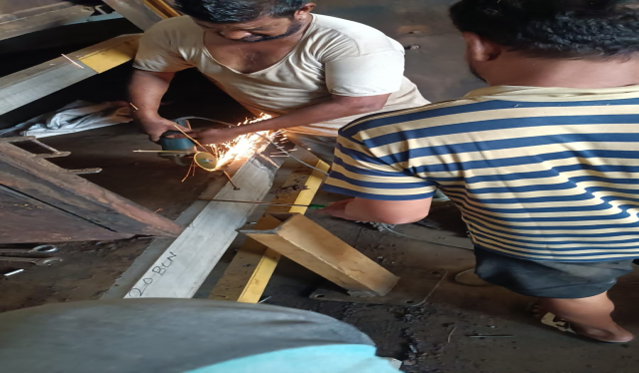

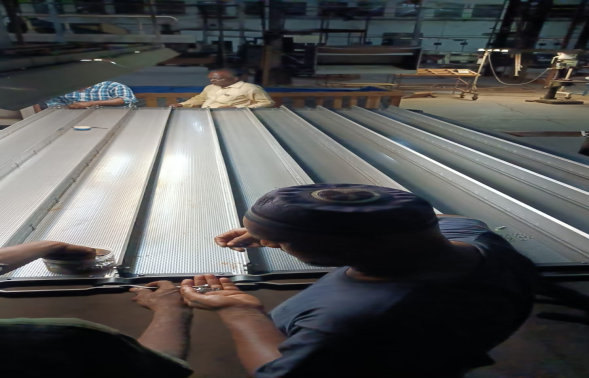

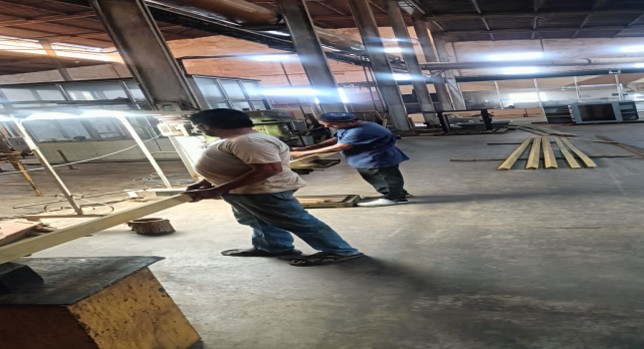

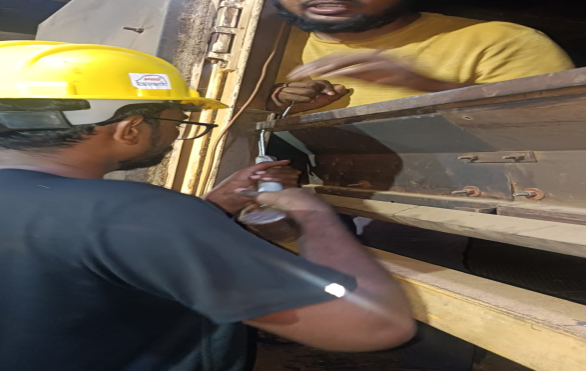

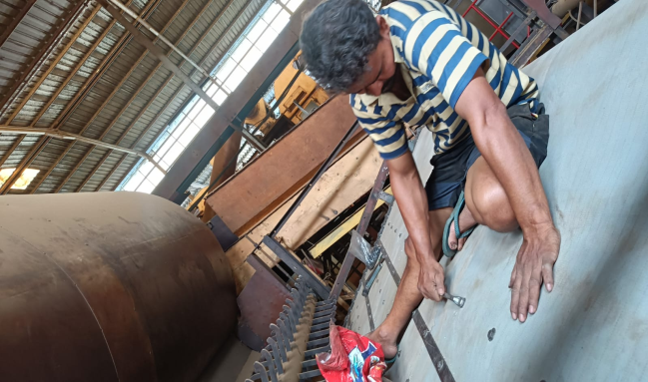

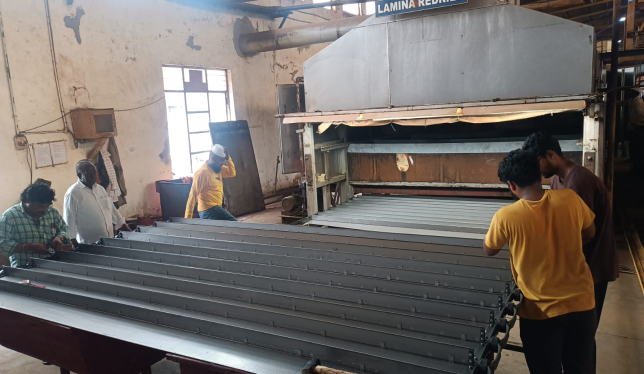

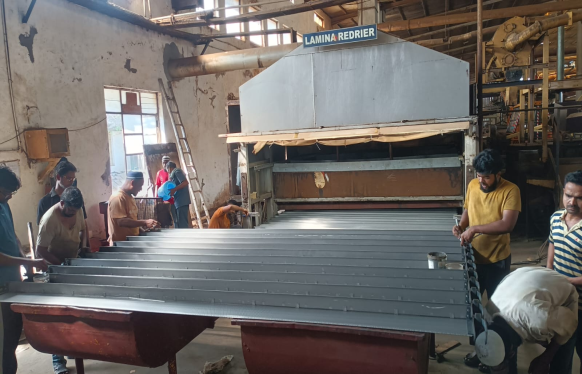

| Lamina Redryer Old Apron Removing Work. 119 Repers Removed. |


Day 02
17/04/2026
| Lamina Redryer Old Apron Removing Work. 205 Repers Removed. |


Day 03
18/04/2026
| Lamina Redryer Old Apron Removing Work. 92 Repers Removed. Total 416 Old Apron Repers Removing Work Completed.LRD Drive Sprockets With Shaft Removed |


Day 04
20/04/2026

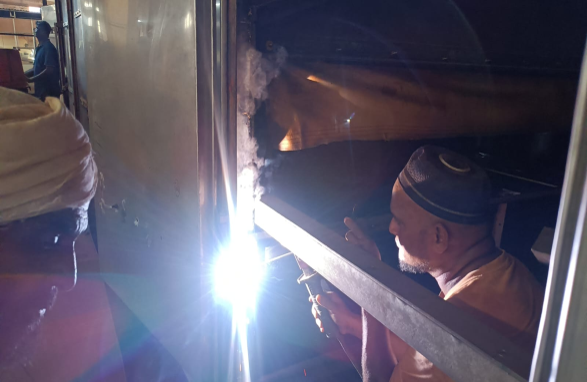

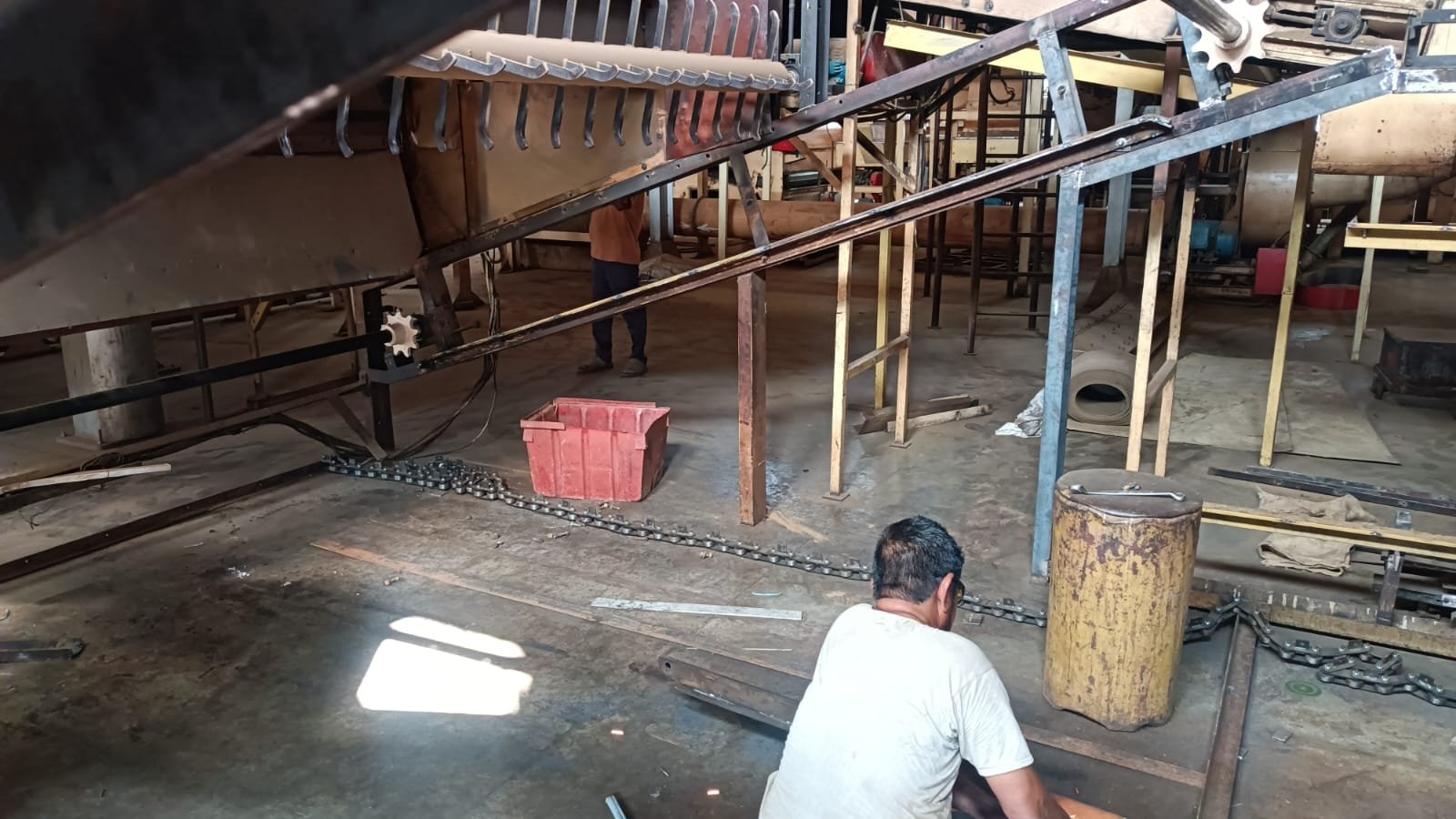

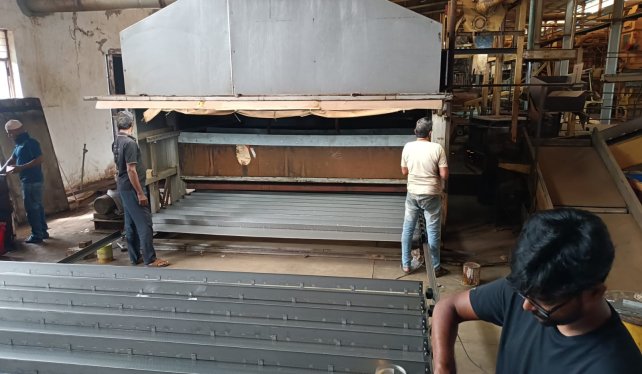

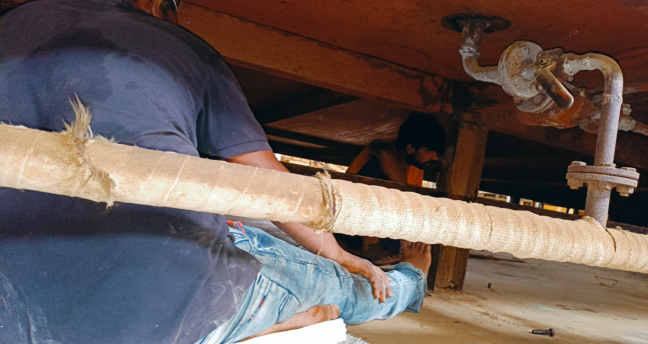

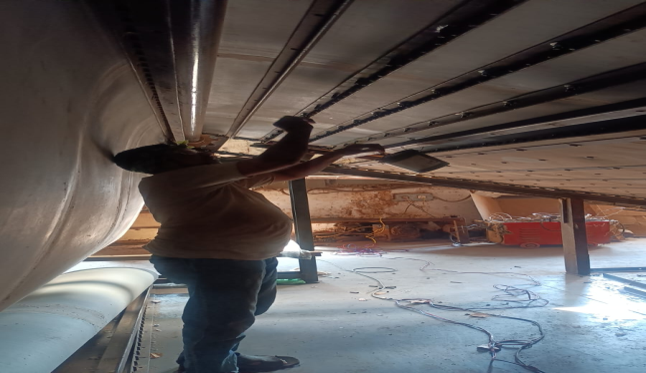

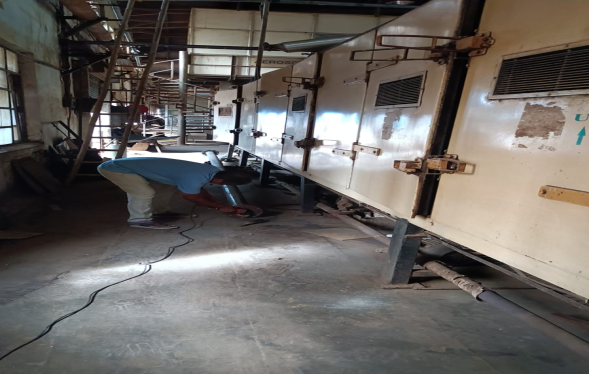

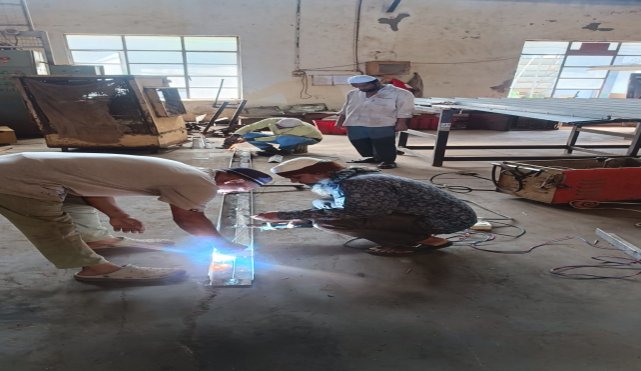

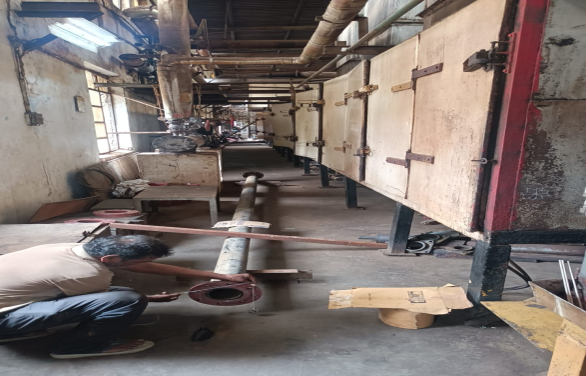

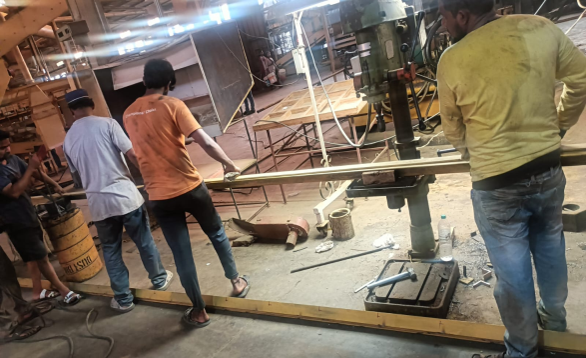

| Lamina Redrey Fans Serviceing Work & Motor Beds Stenghting Work . |


Day 05
21/04/2026
| Lamina Redrey Fans Serviceing Work & Motor Beds Stenghting Work . |


Day 06
22/04/2026
| Lamina Redrey Fans Serviceing Work & Motor Beds Stenghting Work . |


Day 07
23/04/2026
- Total Planned Activity : 4 nos
- Ongoing Activity : 1 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index : 1.7


Day 08
24/04/2026
- Total Planned Activity : 4 nos
- Ongoing Activity : 1 Nos
- Completed Activity : Nil
- Percentage Completion : 0%
- SPI – Scheduled Performance Index : 2.2
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 09
25/04/2026
- Total Planned Activity : 42 nos
- Ongoing Activity : 5 Nos
- Completed Activity : 1
- Percentage Completion : 25%
- SPI – Scheduled Performance Index : 2.1
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 10
27/04/2026
- Total Planned Activity : 42 nos
- Ongoing Activity : 5 Nos
- Completed Activity : 1
- Percentage Completion : 25%
- SPI – Scheduled Performance Index : 2.1
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 11
28/04/2026
- Total Planned Activity : 42 nos
- Ongoing Activity : 5Nos
- Completed Activity : 1
- Percentage Completion : 25%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 12
30/04/2026
- Total Planned Activity : 4 nos
- Ongoing Activity : 1 Nos
- Completed Activity : 1
- Percentage Completion : 25%
- SPI – Scheduled Performance Index : 2.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 13
29/04/2026
- Total Planned Activity : 10 nos
- Ongoing Activity : 2 Nos
- Completed Activity : 1
- Percentage Completion : 25%
- SPI – Scheduled Performance Index : 2.1
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 14
01/05/2026
- Total Planned Activity : 10 nos
- Ongoing Activity : 1 Nos
- Completed Activity : 1
- Percentage Completion : 0%
- SPI – Scheduled Performance Index : 1.0
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 15
02/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 1
- Completed Activity : 1
- Percentage Completion : 25%
- SPI – Scheduled Performance Index : 1.9
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 16
04/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 1
- Completed Activity : 1
- Percentage Completion : 25%
- SPI – Scheduled Performance Index : 1.7
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 17
05/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 1
- Completed Activity : 1
- Percentage Completion : 25%
- SPI – Scheduled Performance Index : 1.6
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 18
06/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 2
- Percentage Completion : 20%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 19
07/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 2
- Percentage Completion : 20%
- SPI – Scheduled Performance Index : 1.5
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 20
08/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity :2
- Percentage Completion : 20%
- SPI – Scheduled Performance Index : 1.4
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 21
09/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 2
- Percentage Completion : 20%
- SPI – Scheduled Performance Index : 1.3
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 22
11/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 1
- Completed Activity : 2
- Percentage Completion : 20%
- SPI – Scheduled Performance Index : 0.22
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 23
12/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 1
- Completed Activity : 2
- Percentage Completion : 20%
- SPI – Scheduled Performance Index : 0.24
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 24
13/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 1
- Completed Activity : 2
- Percentage Completion : 20%
- SPI – Scheduled Performance Index :0.25
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 25
14/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.26
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 26
16/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.28
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 27
17/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.29
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 28
18/05/26
- Total Planned Activity :10 nos
- Ongoing Activity : 1
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.35
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 29
19/05/26
- Total Planned Activity :10 nos
- Ongoing Activity : 1
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.36
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 30
20/05/26
- Total Planned Activity : 10nos
- Ongoing Activity : 1
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.36
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)



Day 31
21/05/26
- Total Planned Activity :10 nos
- Ongoing Activity : 1
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index :0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 32
22/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 1
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.40
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 33
23/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.41
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 34
25/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.43
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 35
26/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.44
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 36
27/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.45
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedul


Day 37
29/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 38
30/05/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule


Day 39
01/06/26
- Total Planned Activity : 10 nos
- Ongoing Activity : 2
- Completed Activity : 3
- Percentage Completion : 30%
- SPI – Scheduled Performance Index : 0.47
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 40
02.06.2026
- Total Planned Activity : 11
- Ongoing Activity : 2
- Completed Activity : 5
- Percentage Completion : 46
- SPI – Scheduled Performance Index: 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 41
03.06.2026
- Total Planned Activity : 11
- Ongoing Activity : 2
- Completed Activity : 5
- Percentage Completion : 46%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 42
04.06.26
- Total Planned Activity : 11
- Ongoing Activity : 2
- Completed Activity : 5
- Percentage Completion : 46%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 43
05.06.26
- Total Planned Activity : 11
- Ongoing Activity : 2
- Completed Activity : 5
- Percentage Completion : 46%
- SPI – Scheduled Performance Index :0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 44
06.06.26
- Total Planned Activity :11
- Ongoing Activity :2
- Completed Activity : 5
- Percentage Completion : 46%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedule)


Day 45
08.06.26
- Total Planned Activity : 11
- Ongoing Activity : 2
- Completed Activity :5
- Percentage Completion : 46%
- SPI – Scheduled Performance Index : 0.62
If SPI = 1 (OK) if SPI less than 1 (Behind Schedule) if SPI More than 1 (Good – Ahead of Schedul
